The ProProfs editorial team is comprised of experienced subject matter experts. They've collectively created over 10,000 quizzes and lessons, serving over 100 million users. Our team includes in-house content moderators and subject matter experts, as well as a global network of rigorously trained contributors. All adhere to our comprehensive editorial guidelines, ensuring the delivery of high-quality content.
Learn about Our Editorial Process
| By Hapolaya
H
Hapolaya
Community Contributor
Quizzes Created: 6 | Total Attempts: 9,358
| Attempts: 556 | preguntas: 200
Please wait...
.
Question 1 / 200
0 %
0/100
Score 0/100
1. Los miembros del equipo de trabajo acaban de finalizar con la creación de la estructura de desglose del trabajo (EDT). Ahora quieren crear el diccionario de la EDT. ¿Cuál será la PRINCIPAL característica de la EDT?

Explanation

The main characteristic of the EDT is that it divides the project into smaller parts to facilitate the planning processes. This allows the team to break down the project into manageable components, making it easier to assign tasks, estimate resources, and create a detailed project plan. By dividing the project into smaller parts, the team can also ensure that all aspects of the project are considered and accounted for in the planning phase.

Submit
Please wait...
About This Quiz
Pmi - Lledo - 6ta Edicin Final - Quiz

Tell us your name to personalize your report, certificate & get on the leaderboard!
2. Tu Cliente no está conforme con el avance del proyecto y se queja porque uno de los entregables definidos en el contrato no se tuvo en cuenta. Por otro lado, tu empresa afirma que ese entregable no estaba definido en el contrato, por lo que no forma parte del proyecto. Es probable que las partes utilicen técnicas de arbitraje y mediación para poder llegar a un acuerdo. ¿Qué tipo de técnicas son estas?

Explanation

The likely technique that the parties would use in this situation is negotiation. Since there is a disagreement about whether the deliverable was defined in the contract or not, the parties would need to engage in a negotiation process to reach a resolution. Negotiation involves discussing and bargaining to find a mutually acceptable solution. In this case, the client and the company would need to negotiate to determine if the deliverable should be included in the project or not.

Submit
3. Estás trabajando en un proyecto para la demolición de un antiguo edificio. Entre las actividades de este proyecto se encuentran la "demolición de paredes" y la "recolección de escombros". ¿Qué tipo de secuencia tienen estas dos actividades?

Explanation

The correct answer is "Lógica dura" because the two activities mentioned, "demolición de paredes" (demolition of walls) and "recolección de escombros" (collection of debris), are sequential and must be completed in a specific order. The demolition of walls must be done before the collection of debris can take place. This type of sequence follows a rigid logic and cannot be changed or altered.

Submit
4. En su empresa deciden que van a invitar a los vendedores a una licitación para proveer uno de los entregables del proyecto de alcance bien definido. ¿Qué tipo de contrato generalmente se utiliza para este tipo de documentación?

Explanation

A fixed price contract is generally used for this type of documentation because it provides a set price for the deliverable, regardless of the actual costs incurred. This type of contract is suitable when the scope of work is well-defined and the risks are low. It allows for better budgeting and cost control as the price is predetermined and does not change based on the actual costs or time spent on the project.

Submit
5. Un proyecto ha estimado gastar como más probable un valor de $100.000 para llevar a cabo todas las actividades. Si se quiere trabajar con un nivel de precisión definitivo, ¿Cuál podría ser el costo estimado para el proyecto?

Explanation

The correct answer is "Entre 90.000 y 115.000". This is because the project has estimated a most likely cost of $100,000 to carry out all the activities. If a definitive level of precision is desired, the estimated cost for the project could fall within a range of $90,000 to $115,000.

Submit
6. A lo largo del ciclo de vida de un proyecto de $23 millones y un plazo de ejecución de 3 años, se sigue el control integrado de cambios para asegurar que cualquier cambio en el proyecto sea beneficioso. ¿Cuál de los siguientes ítems es necesario para comenzar con el control integrado de cambios en ese tipo de proyectos?

Explanation

To begin the integrated change control process in a project, it is necessary to have a list of requested changes. These requested changes can come from various stakeholders and may include modifications to project scope, schedule, or budget. By having a clear understanding of the changes requested, the project team can evaluate their impact, assess their feasibility, and make informed decisions on whether to approve or reject them. Therefore, having a list of changes requested is essential to initiate the integrated change control process in a project.

Submit
7. El proyecto con ciclo de vida predictivo ha llegado a su etapa de cierre. El costo total del proyecto fue de $26 millones y el plazo de ejecución de 32 meses ¿Cuál es la PRINCIPAL característica de esta etapa del proyecto?

Explanation

The main characteristic of the closing stage of a predictive life cycle project is that it generally consumes fewer resources compared to the execution stage. This means that during the closing stage, there is a decrease in the allocation of resources such as time, money, and manpower. This is because the project is nearing completion and most of the major tasks and activities have already been accomplished. The focus during this stage is on finalizing the production of the project deliverables and wrapping up any remaining tasks or documentation.

Submit
8. Hay un grupo de interesados que no está colaborando con un proyecto de desarrollo de materias primas para utilizar en la extracción de petróleo. Estos interesados tienen alto poder para influir en el proyecto, pero están poco interesados en el mismo. ¿Qué sería lo más recomendable para gestionar a estos interesados?

Explanation

The most recommended approach to managing these stakeholders is to keep them satisfied. Although they have high power to influence the project, their lack of interest indicates that they may not actively engage or contribute. By ensuring their satisfaction, their potential negative impact on the project can be minimized. This can be achieved by addressing their needs and concerns, providing regular updates, and involving them in decision-making processes to maintain their support and cooperation.

Submit
9. En su proyecto están utilizando un software de gestión de proyectos para la etapa de monitoreo y control. El director del proyecto le entrega un reporte con la siguiente información. ¿Cómo está ese proyecto?

Explanation

The project is progressing slowly but is spending less than what was planned.

Submit
10. Usted tiene la opción de alquilar andamios para un proyecto de construcción a un costo de $120 por día con los gastos de mantenimiento y custodia incluidos. La alternativa que enfrenta es comprarlos por $3.000 y pagar el costo de vigilancia de $90 por día. ¿Cuántos días debería utilizar los andamios para que el costo de comprar sea equivalente al costo de alquilar?

Explanation

To calculate the number of days needed for the cost of buying to be equivalent to the cost of renting, we need to set up an equation. Let "x" represent the number of days.

The cost of renting for "x" days would be 120*x.
The cost of buying would be 3000 + 90*x (the initial cost of buying plus the cost of surveillance for "x" days).

Setting these two costs equal to each other, we get the equation 120*x = 3000 + 90*x.

Simplifying the equation, we find 30*x = 3000.
Dividing both sides by 30, we get x = 100.

Therefore, it would take 100 days of using the scaffolding for the cost of buying to be equivalent to the cost of renting.

Submit
11. Usted está ejecutando un proyecto que involucra a 23 interesados internos y 17 interesados externos. Debido al gran número de canales de comunicación se están generando conflictos entre distintos grupos de interesados. ¿Qué herramienta para la resolución de conflictos debería utilizar si quiere soluciones de largo plazo?

Explanation

The correct answer is "Colaborar" (Collaborate). When there are conflicts between different groups of stakeholders due to the large number of communication channels, collaborating is the most effective tool for finding long-term solutions. Collaboration involves actively involving all stakeholders in the decision-making process and working together to find mutually beneficial solutions. This approach promotes open communication, understanding, and cooperation among stakeholders, leading to resolutions that address the underlying issues and create lasting agreements.

Submit
12. Un proyecto para la instalación de torres para cables de electricidad involucra a 75 interesados. Hace unos meses que las comunicaciones internas y externas del proyecto están siendo muy mal manejadas. Por tal motivo, se ha contratado a un coordinador del proyecto para que colabore en la solución de este problema. ¿Qué diferencia existe entre un coordinador de proyecto y un facilitador del proyecto?

Explanation

The correct answer is "El coordinador puede tomar algunas decisiones". This means that the coordinator has the authority to make certain decisions without needing authorization from the project director. This is different from a facilitator, who may not have the same decision-making power and may need to consult with the project director before making any decisions.

Submit
13. Estás convencido de que la confianza, las relaciones estrechas y la sutileza son la clave para un proyecto exitoso. ¿Qué teoría de gestión de recursos humanos estarías avalando?

Explanation

The correct answer is "Teoría Z de Ouchi". This theory of human resource management emphasizes the importance of trust, close relationships, and subtlety in achieving successful projects. It suggests that by fostering a sense of community and creating a supportive work environment, employees will be motivated to work collaboratively and achieve high levels of productivity. This theory aligns with the belief that building strong relationships and creating a positive work culture are essential for project success.

Submit
14. Usted es el director de un proyecto que tiene un índice de desempeño del costo de 1,2 y un índice de desempeño del cronograma de 1,1. El equipo del proyecto tiene 5 miembros. El cliente ha aceptado formalmente 10 entregables sin ninguna queja y la matriz de asignación de roles y responsabilidades no ha cambiado desde que se inició el proyecto. El proyecto se desarrolla en una organización matricial fuerte. Aunque el cliente del proyecto está muy conforme, dos miembros del equipo se quejan constantemente por la cantidad de esfuerzo que están dedicando diariamente a las actividades de este proyecto. ¿Qué es lo MEJOR que podría hacer el director del proyecto?

Explanation

The director of the project should improve the project's reward system. This is because the project has a good cost performance index and schedule performance index, and the client has accepted the deliverables without any complaints. However, two team members are constantly complaining about the amount of effort they are putting into the project. By improving the reward system, the director can motivate the team members and address their concerns, leading to increased satisfaction and productivity.

Submit
15. Eres el director de un proyecto para una reingeniería de procesos de una tienda comercial. El proyecto utilizará ciclos adaptativos iterativos. Antes de comenzar con cada iteración, el presupuesto para esa estimación debe estimarse con gran nivel de detalle. ¿Qué método recomiendas para esas estimaciones?

Explanation

Estimación Ascendente, also known as Bottom-up Estimation, is the recommended method for estimating the budget with a high level of detail before starting each iteration in a project using adaptive iterative cycles. This method involves breaking down the project into smaller tasks and estimating the effort and cost for each task individually. By estimating each task separately, a more accurate and detailed budget can be created, allowing for better planning and control of the project's financial resources.

Submit
16. El gerente de control de calidad está utilizando un diagrama de control para evaluar los desvíos de uno de los entregables del proyecto. El límite de tolerancia máximo que tiene ese entregable es de +/- 1 sigma sobre la media. Todos los productos que no respeten ese rango deberán ser re-diseñados antes de entregarlos al Cliente. Hasta el día de la fecha todos los productos han estado dentro de los límites de control, sin embargo en la última semana se observa que hay siete datos consecutivos por encima de la media, pero por debajo del límite de control y tolerancia máximo. ¿Qué significa esto?

Explanation

This means that the process is currently experiencing a special cause of variation, as there are seven consecutive data points above the mean but below the control limit and tolerance limit. This indicates that there is some specific factor causing the deviation from the expected performance. The quality control manager should investigate and identify the cause of this special cause variation in order to bring the process back under control.

Submit
17. Usted está terminando con la fase de inicio de un proyecto de ampliación de balnearios en una ciudad costera con playas. ¿Cuáles son los principales entregables de este inicio de proyecto?

Explanation

The main deliverables of the project initiation phase are the project charter (acta de constitución del proyecto) and the stakeholder register (registro de interesados). The project charter outlines the project's objectives, scope, and key stakeholders, while the stakeholder register identifies and documents the individuals or groups who may be affected by or have an interest in the project. These deliverables are essential in establishing a clear understanding of the project's purpose, scope, and key stakeholders, which helps set the foundation for successful project execution.

Submit
18. En un proyecto el emisor envía el mensaje al receptor. Sin embargo, el mensaje es mal interpretado. ¿Quién es el responsable de este problema?

Explanation

En este caso, el responsable del problema de la mala interpretación del mensaje es el emisor. Como el emisor es quien envía el mensaje, es su responsabilidad asegurarse de que el mensaje sea claro y comprensible para el receptor. Si el mensaje fue mal interpretado, significa que el emisor no logró transmitir la información de manera efectiva, lo que resultó en la confusión por parte del receptor. Por lo tanto, el emisor es el responsable de este problema.

Submit

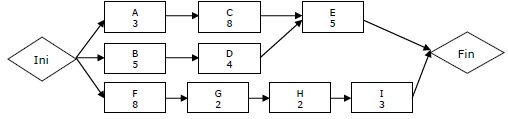

19. Usted necesita acortar la duración de su proyecto que ya está en ejecución. Según los datos de la tabla, ¿Qué actividades seleccionaría para una ejecución rápida?

Explanation

The correct answer is D, F because these activities have the shortest durations according to the table. By selecting these activities for quick execution, the overall duration of the project can be shortened.

Submit
20. La curva S es una gráfica que se utiliza para:

Explanation

The correct answer is "Reportar el desempeño." The S-curve is a graphical representation that shows the planned and actual progress of a project over time. It allows project managers to track and report the performance of the project by comparing the planned schedule with the actual progress. The curve shows the cumulative cost or effort expended on the project over time, allowing stakeholders to assess if the project is on track, behind schedule, or ahead of schedule.

Submit
21. Estás en el proceso de validar el alcance de un entregable con el cliente. ¿Qué es lo más importante que deberías asegurarte?

Explanation

The most important thing to ensure when validating the scope of a deliverable with the client is to obtain formal acceptance from the client. This means that the client has officially approved and acknowledged the deliverable, indicating their satisfaction with its quality and adherence to their requirements. This formal acceptance is crucial as it establishes clear communication and agreement between the client and the project team, ensuring that the deliverable meets the client's expectations and can proceed to the next stage of the project.

Submit
22. Juan y María siempre discuten por temas relacionados con su proyecto. Durante las últimas reuniones, el clima de las discusiones está siendo demasiado agresivo. Ambos miembros del equipo están ubicados en el mismo espacio físico. Usted es el director del proyecto y necesita mejorar esas comunicaciones. ¿Qué debería hacer?

Explanation

The best course of action in this situation would be to request a face-to-face meeting with Juan and María. This allows for open and direct communication, which can help address any misunderstandings or tensions that may be causing the aggressive climate in their discussions. It also provides an opportunity for the project director to mediate and find a resolution that promotes better communication and collaboration between the two team members.

Submit
23. Durante la ejecución de un proyecto de ampliación de un patio de comidas rápidas en un shopping center, los indicadores de avance están muy bien. Sin embargo, los miembros del equipo de trabajo se quejan porque deben elaborar informes a dos áreas distintas dentro de la empresa, y nadie les paga extra por esta duplicación de funciones. Este podría ser un ejemplo de una organización:

Explanation

This scenario could be an example of a matrix organization. In a matrix organization, employees work on projects while also reporting to functional managers. In this case, the team members are complaining about having to submit reports to two different areas within the company, indicating that they have dual reporting responsibilities. This aligns with the characteristics of a matrix organization where employees have multiple reporting lines and may have to fulfill different roles or responsibilities.

Submit

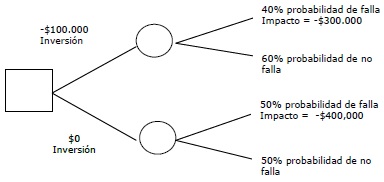

24. Según la figura, calcule el valor monetario esperado (VME) y señale la respuesta CORRECTA

Explanation

Based on the given information, the correct answer is "Es preferible no invertir porque el VME asciende a -200.000" (It is preferable not to invest because the Expected Monetary Value (EMV) amounts to -200,000). This means that the expected value of the investment is negative, indicating a potential loss of 200,000. Therefore, it is more advantageous not to invest in this scenario.

Submit
25. En un proyecto de diseño industrial el director del proyecto decide implementar una ejecución rápida entre algunas actividades. ¿Qué puede ocurrir en este proyecto?

Explanation

Cuando se implementa una ejecución rápida entre algunas actividades en un proyecto de diseño industrial, puede ocurrir un incremento en el nivel de riesgo. Esto se debe a que al acelerar el proceso, se pueden pasar por alto ciertos controles de calidad o etapas de revisión, lo que aumenta la probabilidad de cometer errores o de que surjan problemas en el proyecto. Además, la falta de tiempo puede generar presión sobre el equipo, lo que a su vez puede afectar negativamente la calidad del trabajo realizado. Por lo tanto, implementar una ejecución rápida puede aumentar los riesgos asociados al proyecto.

Submit
26. El equipo de proyectos está desarrollando el plan para la gestión de los interesados analizando sus necesidades, intereses e impactos potenciales. ¿Cuál es el principal motivo para involucrar a los interesados con las decisiones del proyecto?

Explanation

Involving stakeholders in project decisions is important in order to manage their expectations and ensure that the project's objectives are achieved. By analyzing their needs, interests, and potential impacts, the project team can better understand the stakeholders' expectations and work towards meeting them. This helps to build trust and collaboration, leading to a more successful project outcome.

Submit
27. Usted es el director de un proyecto de ampliación de un aeropuerto que funciona como hub. Una de las actividades de ese proyecto consiste en cambiar los pisos actuales por pisos más modernos. Esta actividad va a ser tercerizada a un vendedor. Pero usted necesita conocer cómo va a realizar esa actividad la empresa vendedora sin interrumpir con el normal funcionamiento del aeropuerto. ¿Qué tipo de documentación sería lo más apropiado para que elabore el gerente de contrataciones?

Explanation

The most appropriate type of documentation for the manager of procurement to develop would be a Request for Proposal (RFP). This is because an RFP allows the manager to outline the project requirements and expectations, and request potential vendors to submit detailed proposals on how they plan to carry out the activity of changing the current floors to more modern ones without disrupting the normal functioning of the airport. The RFP will provide the necessary information for the manager to evaluate and select the best vendor for the project.

Submit
28. El proyecto ha entrado en su etapa de ejecución y todo avanza a la perfección hasta que el Cliente solicita un cambio de último momento. Este cambio aumentará el alcance y los costos del proyecto. El Cliente pagará todos los adicionales que sean necesarios. ¿Qué es lo próximo que debería hacer en su rol de director del proyecto?

Explanation

The next step for the project manager is to evaluate how this change will impact the other constraints of the project. This is important because a change in scope and costs can have ripple effects on the project timeline, resources, and quality. By assessing the impact, the project manager can make informed decisions and develop a plan to address any potential issues or risks that may arise from the change. This step is crucial in ensuring that the project can continue to progress smoothly despite the requested change.

Submit
29. ¿Cuál de los siguientes enunciados NO es una ventaja principal de la estructura de desglose del trabajo?

Explanation

The correct answer is "Detalla el trabajo a realizar en cada paquete de trabajo y menciona a los responsables." This statement is not a main advantage of the work breakdown structure. The main advantages of the work breakdown structure include providing a base for estimating people, time, costs, roles, and responsibilities, facilitating communication, and facilitating integrated change control. The statement in the answer choice simply describes one aspect of the work breakdown structure but does not highlight its main advantages.

Submit
30. ¿Cuál es la desviación estándar de una actividad cuya duración más probable es 50 días, el escenario optimista es de 40 días y el escenario pesimista asciende a 80 días?

Explanation

The correct answer is 6,67. The standard deviation is a measure of the spread or variability of a set of values. In this case, the most probable duration is 50 days, the optimistic scenario is 40 days, and the pessimistic scenario is 80 days. By using the formula for standard deviation in a three-point estimation, which is (pessimistic - optimistic) / 6, the result is (80 - 40) / 6 = 6,67. This means that the activity is expected to vary around 6,67 days from the most probable duration of 50 days.

Submit
31. Durante la ejecución de un proyecto de construcción de una red de distribución de energía, el subcontratista propone cambiar algunos materiales que figuran en el contrato de precio fijo por otros más modernos. Este cambio mejorará la calidad del entregable sin afectar las otras restricciones del proyecto. Después que el cambio sea aprobado, ¿en qué documento debería registrarse ese cambio?

Explanation

The change proposed by the subcontractor to replace some materials in the construction project should be registered in the "Plan de gestión de las adquisiciones" (Procurement Management Plan). This plan outlines the processes and procedures for acquiring the necessary materials and resources for the project. By documenting the change in this plan, it ensures that the change is properly managed and communicated to all relevant stakeholders involved in the procurement process. The other options, such as the "Línea base" (Baseline), "Plan de gestión de las comunicaciones" (Communication Management Plan), and "Activos de los procesos de la organización" (Organizational Process Assets), are not specifically related to recording changes in materials for a construction project.

Submit
32. Un proyecto tiene al mes 3 un valor planificado de $300, un costo actual de $220 y un valor ganado de $250. El costo presupuestado a la finalización en el mes 6 asciende a $600. ¿Cuál será la variación del costo y el índice de desempeño del cronograma?

Explanation

The variation of cost is 30, which means that the project is currently under budget by $30. The schedule performance index (SPI) is 0.83, which indicates that the project is behind schedule. This means that the project is not progressing as planned and is taking longer than expected to complete.

Submit
33. Usted contrató a la Empresa "Comerciales" para realizar el diseño de una campaña publicitaria para el lanzamiento de un nuevo producto. El diseño de esta publicidad costó $50.000. Usted pagó un 40% al contado, 30% con cheque a 30 días y 30% con cheque a 60 días. El departamento comercial todavía no está seguro si ese producto tendrá demanda o no, por lo que están evaluando la posibilidad de no hacer el lanzamiento publicitario. ¿Qué costo de ese estudio debería tener en cuenta para tomar la decisión de lanzar el producto al mercado?

Explanation

The cost of the advertising campaign should be considered as $0 when deciding whether to launch the product in the market. This is because the department is unsure if the product will have demand or not, so they are evaluating the possibility of not proceeding with the advertising launch. Therefore, the cost of the study should not be a factor in the decision-making process.

Submit
34. En un proyecto con una estructura matricial fuerte, las principales características serán que el director del proyecto tendrá:

Explanation

En un proyecto con una estructura matricial fuerte, el director del proyecto tendrá una alta autoridad, lo que significa que tiene el poder y la capacidad de tomar decisiones importantes y dirigir el proyecto de manera efectiva. Sin embargo, la disponibilidad de recursos será moderada, lo que implica que puede haber limitaciones en términos de personal, financiamiento y otros recursos necesarios para llevar a cabo el proyecto. Además, se espera que el director del proyecto tenga una dedicación completa, lo que significa que debe estar completamente comprometido y dedicado al proyecto para garantizar su éxito.

Submit
35. Suponga que un proyecto tiene 2 actividades críticas con la siguiente estimación de duraciones (en días): Actividad A: optimista (12), más probable (16), pesimista (32); Actividad B: optimista (2), más probable (4), pesimista (12) ¿Cuál será la duración del proyecto en un rango del 95,45%?

Explanation

The duration of the project can be calculated using the PERT formula, which takes into account the optimistic, most likely, and pessimistic estimates of each activity. For Activity A, the expected duration is calculated as (12 + 4(16) + 32)/6 = 16 days. For Activity B, the expected duration is calculated as (2 + 4(4) + 12)/6 = 4 days. The total expected duration of the project is the sum of the expected durations of both activities, which is 16 + 4 = 20 days. The range of the project duration at a 95.45% confidence level is calculated as ±1.96 times the standard deviation. The standard deviation can be calculated as (32 - 12)/6 = 3.33 days for Activity A and (12 - 2)/6 = 1.67 days for Activity B. The total standard deviation is calculated as √(3.33^2 + 1.67^2) = 3.71 days. Therefore, the range of the project duration is 20 ± 1.96(3.71) = 20 ± 7.27, which gives a range of 12.73 to 27.27 days. The closest range to this is 15.54 - 30.46 days, which is the correct answer.

Submit
36. Usted está evaluando un proyecto de elaboración de alimentos muy grande donde la calidad es sumamente importante. Durante el proceso de planificar la calidad obtendrá los siguientes resultados, a EXCEPCIÓN de:

Explanation

During the quality planning process, you will obtain metrics of quality, quality checklists, and updates to the requirements traceability matrix. However, the exception is that you will not obtain corrective actions. Corrective actions are taken during the quality control process to address any identified quality issues or non-conformities.

Submit
37. Estas trabajando como director de proyecto para la construcción y puesta en marcha de 30 nuevas escuelas para el sector público. Luego de realizar la conferencia de oferentes para aclarar dudas a los vendedores, cinco vendedores responden la solicitud de propuesta. Dos de ellos envían propuestas de precio fijo, uno envía una propuesta de reembolso de costos, otro envía una propuesta de precio fijo con ajuste de precio económico y el último envía una propuesta por tiempo y materiales. ¿Cuál de esas propuestas tendrá menor riesgo de costo para el comprador?

Explanation

The fixed price proposal will have the lowest cost risk for the buyer. This is because with a fixed price proposal, the buyer knows exactly how much they will be paying for the project, regardless of any cost fluctuations or unforeseen circumstances. On the other hand, proposals such as cost reimbursement, fixed price with economic price adjustment, and time and materials, all involve some level of uncertainty and potential for additional costs.

Submit
38. Durante el grupo de procesos de inicio, se están evaluando una serie de proyectos de inversión para ver con cuál de ellos comenzar. El costo de oportunidad del dinero de la Empresa es del 12% anual. El proyecto A tiene una TIR de 8%, el proyecto B tiene una TIR del 10% y el proyecto C tiene una TIR del 6%. Estos proyectos son excluyentes entre sí y no son repetibles en el tiempo. ¿Cuál de estos proyectos debería seleccionar?

Explanation

The cost of opportunity for the company is 12% annually, which means that any project selected should have a higher return than this rate. However, the TIR (internal rate of return) for all the projects is lower than 12%. Therefore, none of these projects should be selected as they do not meet the company's minimum required return.

Submit
39. El patrocinador ha firmado el acta de constitución del proyecto durante el grupo de procesos de inicio. ¿Cuál es la PRINCIPAL característica de este documento?

Explanation

This document identifies the project and its importance for the organization. It serves as a formal acknowledgement and agreement from the sponsor, indicating their support and commitment to the project. It helps establish the project's objectives, scope, and overall purpose within the organization. Without this document, it would be difficult to obtain the necessary resources and support for the project to proceed.

Submit
40. Usted y su equipo ya finalizaron el plan de gestión de riesgos y van a comenzar con el proceso de identificación de riesgos. Están trabajando en un proyecto de desarrollo de software. ¿Cuál de los siguientes elementos sería el MÁS importante en la etapa que va a comenzar?

Explanation

The most important element in the stage of risk identification in a software development project would be the Work Breakdown Structure (WBS). This is because the WBS provides a hierarchical breakdown of the project's deliverables, which allows for a systematic identification of potential risks associated with each component. By analyzing the WBS, the team can identify and assess risks more effectively, helping them to develop a comprehensive risk management plan.

Submit
41. El director del proyecto está discutiendo con el gerente de calidad en relación a los términos precisión y exactitud. En relación a estos conceptos, ¿Cuál de los siguientes enunciado es FALSO?

Explanation

The statement "Precisión y exactitud son sinónimos" is false. Precision and accuracy are related but not synonymous concepts in the context of data analysis. Precision refers to the consistency and reproducibility of measurements, while accuracy refers to how close the measurements are to the true or target value. In other words, precision is about the level of variation or scatter in the data, while accuracy is about the level of bias or systematic error. Therefore, it is possible to have precision without accuracy and vice versa.

Submit
42. Usted está realizando un monitoreo y control del proyecto en función de la tabla a continuación, ¿La línea base de costo al finalizar el quinto mes será?

Explanation

Based on the information provided in the question, the correct answer of 2920 can be determined by analyzing the "tabla" or table mentioned. This table likely contains data related to the project's cost monitoring and control. By examining the table, it can be inferred that the "línea base de costo" or cost baseline at the end of the fifth month is 2920.

Submit
43. Eres director del proyecto para la puesta en marcha de una planta potabilizadora de agua de mar. Ya has finalizado con la planificación y está todo listo para empezar con la ejecución. Para ello necesitarás adquirir a personal especializado para realizar ciertas actividades. Sin embargo, no podrás contratar a quién tú quieras, ya que en el acta de constitución del proyecto ya han sido nombrados miembros del equipo para realizar esas funciones. ¿Esto sería un ejemplo de?

Explanation

This scenario is an example of "Asignación previa" or "pre-assignment" in English. It means that the project team members have already been assigned specific roles and responsibilities for carrying out certain activities. As a project director, you cannot hire anyone you want because the team members have already been designated in the project charter to perform those functions. This is a predetermined allocation of resources based on the project plan and requirements.

Submit
44. El patrocinador de un proyecto está buscando el perfil ideal de una persona para nombrarlo director de proyecto en una empresa de alta tecnología de los alimentos. Esta es una empresa con estructura funcional y la mayoría de sus empleados son ingenieros que utilizan un lenguaje técnico. ¿Qué es lo más importante que debería tener en cuenta el patrocinador al momento de seleccionar al director del proyecto?

Explanation

The most important factor that the sponsor should consider when selecting the project director is their communication and integration skills. This is because the company has a functional structure and most of its employees are engineers who use technical language. Therefore, the project director needs to be able to effectively communicate with and integrate the diverse technical teams in order to successfully manage the project.

Submit
45. Usted se encuentra planificando las necesidades de recursos para un nuevo proyecto que necesitará 46 trabajadores. Cada uno de ellos debe tener muy claro desde el inicio cuál es su responsabilidad para cada uno de los paquetes de trabajo del proyecto. Una vez finalizada la estructura de desglose del trabajo, decide elaborar una matriz de roles y responsabilidades. ¿Qué diferencia existe entre rol y responsabilidad?

Explanation

The correct answer explains that "Responsable" refers to the person who must ensure that the activity is carried out properly. This implies that the responsible person has the duty to achieve the desired outcome or result. The answer accurately describes the difference between "rol" (role) and "responsabilidad" (responsibility), highlighting that the role refers to who decides what to do, while responsibility refers to who ensures the proper execution of the activity.

Submit
46. En un proyecto complejo se ha definido a la variable "calidad" como la restricción más importante del proyecto. Este proyecto no se ha realizado antes en tu organización ni en otras empresas. ¿Qué es lo MEJOR que podrás hacer en tu rol de director del proyecto?

Explanation

In a complex project where "quality" is defined as the most important constraint, the best thing the project manager can do is to audit the work as it is being completed in order to identify actions for continuous improvement. This is because auditing the work allows for early detection of any issues or areas for improvement, which can then be addressed and corrected in a timely manner. Continuous improvement is crucial in ensuring that the project meets the defined quality standards and ultimately achieves success.

Submit
47. Su proyecto utiliza metodologías ágiles para desarrollar una solución a un problema ambiental. Los usuarios externos utilizan cajas negras, mientras que los desarrolladores internos utilizan cajas blancas. ¿En qué proceso están trabajando?

Explanation

The project is using agile methodologies to develop a solution to an environmental problem. The external users are using black boxes, while the internal developers are using white boxes. Based on this information, the team is working on "Control de calidad" or quality control. They are likely testing and ensuring the quality of the solution being developed, using both black box testing by external users and white box testing by internal developers.

Submit
48. La estructura de desglose del trabajo suele ser utilizada para las comunicaciones ____________

Explanation

The work breakdown structure is commonly used for both internal and external communications. It helps to break down the project into smaller, manageable components, making it easier to communicate progress, responsibilities, and deliverables to both the project team and external stakeholders such as clients. This allows for effective communication and coordination between all parties involved in the project, ensuring that everyone is on the same page and working towards the same goals.

Submit
49. Un proyecto se encuentra con un nivel de avance del 67%. La semana pasada el proyecto tuvo que ser frenado porque el principal contratista fue suspendido de las obras por violar una cláusula de calidad establecida en el contrato. Recientemente se acaba de contratar a otro vendedor para que continúe con las actividades del proyecto. ¿Qué es lo más importante que debería comunicar al nuevo contratista en la reunión inicial?

Explanation

In this scenario, the most important thing to communicate to the new contractor in the initial meeting is to clarify the objectives of the project. This is crucial because the project was halted due to a violation of a quality clause by the previous contractor. By clarifying the objectives, the new contractor will have a clear understanding of what needs to be achieved and can align their activities accordingly. This will help ensure that the project progresses in the right direction and avoids any further violations or delays.

Submit
50. Uno de los miembros del equipo de proyecto le ha solicitado más tiempo para implementar una modificación en una actividad en la que está trabajando. Usted descubre que un retraso en dicha actividad causará un retraso en uno de los caminos con holgura. El cliente del proyecto cobrará una multa en caso que el proyecto se entregue fuera de plazo. ¿Qué es lo MEJOR que puede hacer?

Explanation

The best course of action in this situation is to send the information to the change control committee. This is because implementing the requested modification may cause a delay in a critical path activity, which could result in a delay in project delivery. As the client will impose penalties for late delivery, it is important to involve the change control committee to assess the impact of the proposed change and make an informed decision. This ensures that all stakeholders are aware of the potential consequences and can collectively decide on the best course of action.

Submit
51. Los siguientes interesados forman parte de un proyecto en una organización matricial balanceada. ¿Cuál de ellos cree usted que puede influir MENOS en la definición de las actividades del proyecto?

Explanation

The user final of the product or service is the least likely to influence the definition of the project activities. This is because the user is typically not involved in the day-to-day operations of the project and may not have a deep understanding of the technical aspects or constraints of the project. The project team, project manager, and functional manager are more likely to have a direct impact on defining the activities as they are directly involved in the project execution and have a better understanding of the project requirements and constraints.

Submit
52. Usted es el director de un proyecto internacional que proveerá gas licuado a su país vecino. Junto con los miembros del equipo están elaborando el plan de gestión de riesgos. ¿Cuál de los siguientes ítems NO formará parte de este plan?

Explanation

The analysis of assumptions is not part of the risk management plan because it is a separate process that involves identifying and documenting the assumptions made during the planning phase of the project. The risk management plan focuses on identifying, analyzing, and responding to potential risks and uncertainties that may impact the project's objectives. It includes the methodology to be used for risk identification and analysis, the frequency at which risk assessments will be conducted, and the tolerance levels for each identified risk.

Submit
53. Usted y su equipo han decidido una intensificación del proyecto, ¿Qué es lo más probable que suceda en este proyecto?

Explanation

Cuando se decide una intensificación del proyecto, es probable que los costos aumenten. Esto se debe a que una intensificación implica una mayor dedicación de recursos, como tiempo, personal y materiales, lo que puede resultar en gastos adicionales. Al aumentar la intensidad del proyecto, es probable que se requieran más recursos para cumplir con los objetivos y las metas establecidas, lo que a su vez puede aumentar los costos asociados con el proyecto.

Submit
54. Usted está realizando un análisis cuantitativo del riesgo utilizando la simulación de Monte Carlo como complemento de un software de gestión de proyectos. ¿Qué resultado NO obtendrá con esta herramienta?

Explanation

La simulación de Monte Carlo no proporciona información sobre los riesgos del proyecto causados por supuestos imprecisos. Esta herramienta se utiliza para evaluar la probabilidad de finalizar el proyecto antes o después de una determinada fecha, así como para determinar la duración más probable de finalización del proyecto. Sin embargo, no se enfoca en analizar los riesgos causados por supuestos imprecisos.

Submit
55. El director del proyecto y su equipo de trabajo ya han finalizado el cronograma del proyecto. Sin embargo, al observar el histograma de recursos descubren que no cuentan con los trabajadores suficientes para poder cumplir todo el alcance de la forma planificada. El patrocinador les informa que no podrán recortar el alcance del proyecto y que deberán nivelar ese cronograma de la mejor forma posible. ¿Qué es lo mejor que puede hacer?

Explanation

Given the situation where the project manager and the team have already completed the project schedule but realize that they do not have enough workers to fulfill the entire scope as planned, the best option is to postpone the start of activities with positive float. This means delaying the start of certain activities that have some flexibility in their start dates, allowing the team to allocate resources more efficiently and still complete the project within the planned timeframe. This approach ensures that the project scope is not compromised while optimizing resource utilization.

Submit
56. A una de las grandes firmas consultoras del mundo se le incendiaron todas sus oficinas administrativas durante un fin de semana. La empresa tenía sus archivos digitalizados con sistemas de back-up fuera del lugar donde ocurrió el siniestro. Se puso en marcha el plan de respuesta al riesgo comandado por un Comité especial de crisis. La reconstrucción del edificio demoraría 45 días. El comité de crisis decidió reubicar a todos los trabajadores en oficinas alquiladas mientras se arreglaba el edificio. En tan sólo 48 horas, todos los trabajadores estaban trabajando normalmente para sus clientes. ¿Qué tipo de respuesta al riesgo implementó esta firma consultora en relación al sistema de back-up?

Explanation

The correct answer is "Evitar" (Avoid). This is because the consulting firm had implemented a backup system for their digital files, which were stored off-site. In the event of the fire, they were able to recover their files and continue working without major disruptions. This shows that the firm had taken measures to avoid the risk of losing their data and had a plan in place to mitigate the impact of such an incident.

Submit
57. ¿Qué nos indica la desviación estándar de una actividad?

Explanation

La desviación estándar de una actividad indica el riesgo de la estimación. Cuanto mayor sea la desviación estándar, mayor será el riesgo asociado con la estimación de esa actividad. Esto significa que la estimación puede ser menos precisa y más propensa a errores o variaciones. Por lo tanto, la desviación estándar es una medida de la incertidumbre y el riesgo involucrado en la estimación de una actividad.

Submit
58. Una compañía financiera está ampliando su cartera de créditos hipotecarios a clientes de bajos ingresos. Este será un nuevo proyecto con un concepto de negocio distinto a lo que habitualmente realiza la compañía. El director del proyecto ha creado una serie de procesos para asegurar que cada crédito que se otorgue cumpla con la normativa legal vigente. Una vez que el proyecto entre en ejecución, ¿Con qué herramienta podría verificar que esos procesos se están cumpliendo?

Explanation

A lista de verificação é uma ferramenta que pode ser utilizada para verificar se os processos estão sendo cumpridos. Ela consiste em uma lista de itens que devem ser verificados e marcados conforme são concluídos. Nesse caso, a lista de verificação pode ser usada para garantir que cada crédito hipotecário concedido cumpra com a normativa legal vigente, assegurando que todos os requisitos legais sejam atendidos.

Submit
59. Según el siguiente informe de desempeño del proyecto con celdas en blanco que usted debe completar, ¿Cuál es el valor ganado de la actividad B?

Explanation

The value earned of an activity is the percentage of the activity's planned value that has been completed. In this case, the value earned of activity B is 80 because it represents 80% of its planned value.

Submit
60. En una organización matricial balanceada, el director del proyecto le comenta al gerente de recursos humanos que los empleados están convencidos que sus esfuerzos los llevarán a un desempeño efectivo, y por tal motivo serán bien recompensados. ¿Qué teoría afirma este razonamiento?

Explanation

The given correct answer is "Expectativas". This theory suggests that individuals are motivated by their expectations of rewards or outcomes. In a balanced matrix organization, where the project director believes that employees' efforts will lead to effective performance and they will be well rewarded, it aligns with the theory of expectations. This theory implies that individuals are motivated to work harder and perform better when they believe that their efforts will result in desirable outcomes or rewards.

Submit
61. En un proyecto de desarrollo de un nuevo alimento para ancianos, algunos miembros del equipo no están colaborando con el informe de lecciones aprendidas por miedo a sufrir alguna represalia por parte de su cliente. ¿Cuáles de las siguientes herramientas permite mantener el anonimato de los participantes?

Explanation

The correct answer is the Técnica Delphi. The Técnica Delphi allows for anonymity of the participants, which can be beneficial in situations where team members may fear reprisal from the client. This technique involves collecting input from participants anonymously, typically through a series of questionnaires or surveys. By keeping the participants' identities confidential, it creates a safe space for individuals to share their thoughts and opinions without the fear of negative consequences.

Submit
62. Eres el director de un proyecto que fabricará químicos innovadores para la extracción eficiente de petróleo. Has sido contratado por la empresa "Petrolito" para dirigir este proyecto. Cuando el proyecto lleva un 80% de avance, la empresa "Gasolina", competidora directa de la empresa "Petrolito", solicita tus servicios profesionales para fabricar productos iguales a los que estás realizando para la empresa "Petrolito". ¿Qué deberías hacer?

Explanation

Before making a decision, it is important to review the intellectual property clause of the project completed for "Petrolito". This is necessary to determine if there are any restrictions or conflicts of interest that would prevent working on a similar project for "Gasolina". By reviewing the clause, the director can ensure that they are acting ethically and legally, and can make an informed decision based on the terms outlined in the contract with "Petrolito".

Submit
63. Un proyecto indica un índice de desempeño del costo de 0.6. ¿Qué podemos decir de este proyecto?

Explanation

The given correct answer suggests that the project is facing budgetary issues. This means that the project is experiencing difficulties in managing its financial resources and may be exceeding its allocated budget.

Submit
64. Un proyecto de cambio tecnológico tiene varios interesados. Su patrocinador le pide que utilice una comunicación con enfoque multifacético. ¿Qué implica esto?

Explanation

El enfoque multifacético de la comunicación implica que el equipo debe adaptar el mensaje para cada grupo de interesados. Esto significa que se deben tener en cuenta las necesidades, conocimientos y expectativas de cada grupo al comunicarse con ellos. Al adaptar el mensaje, el equipo puede asegurarse de que la información sea clara, relevante y comprensible para cada grupo, lo que facilita la comunicación efectiva y el éxito del proyecto de cambio tecnológico.

Submit
65. Usted y su equipo se encuentran en el grupo de procesos que están consumiendo la mayor parte del tiempo y los recursos de un proyecto de construcción con ciclo de vida predictivo. ¿Qué grupo de procesos suele ser este?

Explanation

The correct answer is "Ejecución" (Execution). In a construction project with a predictive life cycle, the execution phase typically consumes the most time and resources. This phase involves carrying out the planned activities, coordinating the team, and implementing the project plan. It is during this phase that the actual construction work takes place, and it requires a significant amount of time and resources to complete.

Submit
66. Eres el director del proyecto para la provisión de alimentos de un comedor escolar. Los miembros del equipo del proyecto te tienen miedo porque te ven como si fueras el presidente de la empresa. Los miembros del equipo saben que una mala impresión que te lleves de ellos, impactará negativamente en su bono salarial a fin de año. Esto sería un ejemplo de poder __________

Explanation

This situation would be an example of coercive (penalty) power because the team members fear negative consequences, such as a reduction in their end-of-year bonus, if they make a bad impression on the project director. The power is based on the ability to impose penalties or punishments, which creates a sense of fear and compliance among the team members.

Submit
67. Para cerrar exitosamente un proyecto es fundamental documentar los siguientes ítems, a EXCEPCIÓN de:

Explanation

The given answer is "Método de selección del proyecto." This is because the question asks for the item that is NOT fundamental to successfully closing a project. The other three options, "Lecciones aprendidas," "Alcance final del proyecto y su apego a las métricas de calidad," and "Aceptación formal del producto," are all important aspects of project closure as they involve reviewing and documenting lessons learned, ensuring the project meets quality metrics, and obtaining formal acceptance of the final product. However, the method of project selection is not directly related to the closure process.

Submit
68. Eres el director de proyecto en una empresa de telecomunicaciones. Los Informes de desempeño del proyecto utilizan la gestión del valor ganado para comunicar los avances a los interesados. Uno de los miembros del equipo no entiende lo que significa que la variación del cronograma tenga un resultado negativo. Tú le explicas que el proyecto está retrasado en relación a su plan original y que ese indicador se obtiene de la siguiente forma:

Explanation

The correct answer is "La diferencia entre el valor ganado y el valor presupuestado". This means that the variation of the schedule has a negative result when the value earned is less than the budgeted value. In other words, the project is behind schedule compared to the original plan. The variation of the schedule is an important indicator in earned value management as it helps to assess the project's progress and identify any delays or deviations from the planned schedule.

Submit
69. Has sido asignado como director de proyecto para el lanzamiento del próximo cohete espacial. Junto a tu equipo de proyecto están identificando los posibles riesgos que puede enfrentar ese lanzamiento. ¿Cuál sería la MEJOR técnica para utilizar en esta situación?

Explanation

The Delphi technique would be the best technique to use in this situation. The Delphi technique involves gathering input from a group of experts anonymously and then using their feedback to reach a consensus or make decisions. Since the team is identifying potential risks for the rocket launch, using the Delphi technique would allow for a comprehensive and unbiased assessment of the risks by involving the expertise of the team members. This technique would help in identifying and prioritizing the risks effectively, ensuring a more successful and safer rocket launch.

Submit
70. En un proyecto que ha entrado en su tercer año de ejecución, el director del proyecto siente que los empleados están desmotivados, por lo que permanentemente debe decirles qué es lo que deben hacer. Además, luego tiene que estar controlando que realmente hagan lo que se les dijo que hicieran. Qué teoría de la motivación explica esto:

Explanation

The correct answer is "Teoría X". The director of the project feels that the employees are demotivated and constantly needs to tell them what to do and monitor their actions. This aligns with the principles of Theory X, which suggests that employees are inherently lazy and require strict supervision and control to ensure productivity. According to Theory X, employees lack motivation and need external direction to perform their tasks effectively.

Submit
71. Un proyecto tiene una duración estimada de 9 meses. En el segundo mes de ejecución, una de las actividades en la ruta crítica ha tenido un retraso de 10 días por factores climáticos adversos. Esto ha excedido los costos del proyecto, pero está dentro de los límites aceptables. ¿Qué es lo MEJOR que debería hacer?

Explanation

The best thing to do in this situation is to inform the client and sponsor about the actual state of the project. This is important because the project has experienced a delay that has exceeded the project's costs, even though it is still within acceptable limits. By informing the client and sponsor, they can be aware of the situation and make any necessary adjustments or decisions. It is important to maintain transparency and communication in order to manage expectations and ensure the project's success.

Submit
72. Estas trabajando en un proyecto para la construcción de una casa pre-fabricada de $430.000 y una duración estimada de 3 meses. Estas realizando el proyecto por administración de materiales y necesitas seleccionar al equipo de pintores. La selección de los vendedores la podrás realizar según las siguientes técnicas, a EXCEPCIÓN de:

Explanation

La conferencia de oferentes no es una técnica que se puede utilizar para seleccionar al equipo de pintores en este proyecto de construcción. Las otras técnicas mencionadas, como el presupuesto fijo, el sistema de ponderación y el sistema de calificación de vendedores, son opciones válidas para realizar la selección. Sin embargo, la conferencia de oferentes no se menciona como una opción válida en este caso.

Submit
73. La gerencia quiere analizar cómo va evolucionando el proyecto en relación a otros proyectos similares realizados en el pasado. Para hacer un juicio válido, la gerencia debería observar el proyecto en comparación con los otros utilizando la siguiente herramienta:

Explanation

The management wants to analyze how the project is evolving in relation to other similar projects carried out in the past. To make a valid judgment, the management should observe the project in comparison with others using the tool of benchmarking. Benchmarking involves comparing the project's performance, processes, and outcomes with those of other projects or organizations in order to identify best practices, areas for improvement, and opportunities for innovation. This will provide valuable insights for the management to assess the project's progress and make informed decisions.

Submit
74. Usted ha sido asignado como director de proyecto para el diseño de un parque industrial. Tiene gran experiencia en el mundo de los proyectos, pero nunca antes había realizado proyectos relacionados con parques industriales. ¿Qué es lo primero que debería hacer?

Explanation

The first thing the project manager should do is collect historical information on similar projects carried out by the sponsor. This will provide valuable insights and lessons learned from previous projects, helping the project manager understand the challenges, risks, and best practices associated with designing an industrial park. By leveraging the sponsor's past experiences, the project manager can make informed decisions and increase the chances of project success.

Submit
75. En un proyecto de cierre de una central nuclear, durante la etapa de ejecución el director del proyecto les entrega a los interesados, incluyendo al patrocinador, un informe de avance informando el desempeño del proyecto. ¿Cuál será ese informe?

Explanation

During the execution stage of a nuclear power plant closure project, the project manager provides the stakeholders, including the sponsor, with a progress report informing them about the project's performance. This report is known as the "Diagrama del valor ganado" or "Earned Value Diagram." This diagram helps track the project's actual progress compared to the planned progress, including the cost and schedule variances. It provides a visual representation of the project's overall performance and allows stakeholders to assess if the project is on track or if adjustments need to be made.

Submit
76. Un proyecto grande y complejo para la ampliación de un puerto se llevará a cabo en un país extranjero, por lo que requiere gran coordinación para mover equipos por las calles de ese país. Cuáles actividades serán las que le demanden MENOS esfuerzo durante la ejecución de ese proyecto:

Explanation

Defining the organizational structure of the project would require the least effort during the execution of the project. This activity involves determining the roles, responsibilities, and reporting relationships within the project team. It is a one-time task that can be completed at the beginning of the project and does not require ongoing effort or coordination. In contrast, distributing information, implementing contingency plans, and conducting coordination meetings would require continuous effort and coordination throughout the project to ensure effective communication, risk management, and collaboration among team members.

Submit
77. Usted ha finalizado la ejecución de 4 proyectos y en el informe de cierre va a incluir criterios financieros como la TIR (tasa interna de retorno). La tasa que se utilizó en estos proyectos para descontar el flujo de fondos fue del 8%. ¿Qué proyecto fue el mejor desde el punto de vista financiero?

Explanation

The best project from a financial point of view is Project C because it had the highest internal rate of return (TIR) among the four projects. The question states that the discount rate used for the cash flows in these projects was 8%, and based on that rate, Project C had the highest TIR.

Submit
78. El cliente solicita al director del proyecto realizar un cambio sustancial en la tecnología que se quiere utilizar para este proyecto. Solicita reemplazar el cable coaxial por fibra óptica. ¿Cuál es el impacto más importante que debería considerar el director del proyecto?

Explanation

The most important impact that the project director should consider is the restrictions of the project, including scope, time, and cost. Changing the technology from coaxial cable to fiber optic will likely have implications on the project's scope, as it may require additional resources and changes in the project plan. It will also affect the project's time, as the switch to fiber optic may require additional time for installation and testing. Additionally, the change in technology may have cost implications, as fiber optic cables can be more expensive than coaxial cables. Therefore, considering the restrictions of the project is crucial in assessing the feasibility and implications of the requested change.

Submit
79. Junto a su equipo están tratando de estimar los costos operativos de su empresa durante el año próximo. En primer lugar recolecta los registros históricos de esos costos de los últimos 36 meses. Luego utiliza un diagrama de tendencias para ver el comportamiento histórico de esos costos. Aplica a los datos un par de tests estadísticos para corroborar que esa información sea estadísticamente significativa. Finalmente, proyecta los costos operativos futuros con base en esos datos históricos. ¿Qué tipo de estimación está realizando?

Explanation

The team is using historical cost data to estimate the future operational costs of the company. They collect the historical records of these costs over the past 36 months and analyze the trend using a trend diagram. To ensure the statistical significance of the information, they apply a couple of statistical tests to the data. Finally, they project the future operational costs based on these historical data. Therefore, the type of estimation being performed is parametric, as it relies on statistical analysis and historical data to make projections.

Submit
80. Tu empresa está involucrada en un nuevo proyecto de elaboración de alimentos balanceados para animales domésticos, muy similar al realizado el año pasado. ¿Qué es lo primero que debería tener en cuenta para definir las actividades de este proyecto?

Explanation

When starting a new project, the first thing to consider is the organization's process assets. These assets include any templates, guidelines, or previous project documentation that can be used as a reference or starting point for the new project. By leveraging the organization's process assets, the team can benefit from lessons learned and best practices from previous similar projects, ensuring that they do not repeat the same mistakes and can save time and effort in defining the activities for the new project.

Submit
81. Tu último proyecto sobre la redacción de un libro sobre gestión de proyectos está a punto de finalizar. El diseño de tapas fue tercerizado a un estudio de diseñadores gráficos. ¿Qué es lo último que deberías hacer en este proyecto?

Explanation

The last step that should be done in this project is the closure of the project. This involves officially ending the project and ensuring that all project deliverables have been completed and delivered to the client. It also includes conducting a final project review to evaluate its success and identify any lessons learned for future projects. The closure of the project signifies the completion of all project activities and the handover of the final product to the client.

Submit
82. En un proyecto relacionado con la desnutrición infantil, las maestras comentan que los niños no aprenden en el colegio. Según las necesidades de Maslow, ¿Cuál de los siguientes ítems está en la base y podría estar explicando el comentario de las maestras?

Explanation

The correct answer is "Satisfacción fisiológica." According to Maslow's hierarchy of needs, physiological needs such as food, water, and shelter are at the base of the pyramid. If children are suffering from malnutrition, their basic physiological needs are not being met, which can have a negative impact on their ability to learn and concentrate in school. Therefore, the lack of physiological satisfaction could explain the teachers' comment that the children are not learning in school.

Submit
83. En su proyecto han finalizado una EDT bastante compleja con varios niveles jerárquicos. De los ítems mencionados a continuación, ¿Cuál representa el nivel jerárquico superior en la estructura de desglose del trabajo?

Explanation

The correct answer is "Cuenta de control". In the given question, it is stated that a complex WBS (Estructura de Desglose del Trabajo) with multiple hierarchical levels has been completed. The term "Cuenta de control" refers to the highest level in the WBS hierarchy. This means that it represents the overall project or program, under which all the other components such as "Paquete de planificación" (Planning package), "Actividades" (Activities), and "Paquete de trabajo" (Work package) are organized.

Submit
84. Has estado trabajando como director de proyecto en la construcción de un rascacielos en un país extranjero. Tu Cliente, un empresario millonario, quiere regalarte un anillo de diamantes muy lujoso, en agradecimiento por el majestuoso edificio que has finalizado seis meses antes de la fecha estimada. ¿Qué deberías hacer?

Explanation

The correct answer is not to accept the ring because its value exceeds the gift limit allowed by the company's policy. This implies that accepting the expensive diamond ring could be seen as a violation of company policy and potentially as an act of bribery. It is important to adhere to ethical guidelines and maintain integrity in professional relationships.

Submit
85. ¿Durante qué etapa del ciclo de vida de un proyecto publicitario se realiza el cierre administrativo?

Explanation

Durante el ciclo de vida de un proyecto publicitario, se realiza el cierre administrativo al finalizar cada fase del ciclo de vida del proyecto. Esto significa que después de completar cada etapa del proyecto, se deben llevar a cabo actividades de cierre administrativo para asegurar que todos los aspectos del proyecto estén completos y correctamente documentados. Esto incluye la revisión de los entregables, la evaluación del desempeño del equipo y la documentación de lecciones aprendidas. Al realizar el cierre administrativo al finalizar cada fase, se garantiza que el proyecto avance de manera ordenada y se cumplan los objetivos establecidos.

Submit
86. Un proyecto de explotación de recursos naturales está entrando en su etapa final. ¿Qué es lo más importante que debe hacer para cerrar el proyecto?

Explanation

The most important thing to do to close the project is to obtain formal approval from the client. This ensures that the client is satisfied with the project's completion and signifies the official end of the project. Without the client's approval, the project may be considered incomplete and may result in unresolved issues or disputes. Obtaining formal approval also helps in maintaining a good relationship with the client and provides a clear signal that all project objectives have been met.

Submit
87. Un proyecto que consiste en la elaboración de un plan para la dirección del proyecto para la apertura de un nuevo Banco está a punto de culminar. El gerente de contrataciones está realizando una auditoria para determinar en qué estado de cumplimiento se encuentra el contrato con el vendedor. ¿A qué grupo de procesos corresponde esta actividad?

Explanation

The activity of conducting an audit to determine the compliance status of a contract with a vendor is part of the "Monitoreo y control" (Monitoring and control) group of processes. This group involves the ongoing tracking and reviewing of project progress, performance, and contracts to ensure that they are being executed according to the plan. In this case, the manager is assessing the compliance of the contract with the vendor, which falls under the monitoring and control activities of the project.

Submit
88. En una organización matricial balanceada, la mayoría de las comunicaciones entre los interesados será:

Explanation

En una organización matricial balanceada, las comunicaciones entre los interesados serán tanto verticales como horizontales. Esto significa que la información fluirá tanto de arriba hacia abajo y viceversa, como entre los diferentes niveles y departamentos de la organización. Esta estructura de comunicación permite una mayor colaboración y coordinación entre los miembros de la organización, ya que se fomenta el intercambio de información y la toma de decisiones conjuntas. Además, al combinar la comunicación vertical y horizontal, se asegura que la información llegue a todas las partes relevantes de la organización de manera efectiva.

Submit
89. En un proyecto para la elaboración de mosto concentrado para la producción de jugos de exportación, el patrocinador quiere comenzar el proyecto sin cometer errores. Antes de finalizar con el acta de constitución del proyecto, el patrocinador necesitaría conocer los siguientes ítems, a EXCEPCIÓN de:

Explanation

Before finalizing the project charter, the sponsor needs to know the organizational culture, organizational systems, and available human resource skills, as well as the organization's policies and processes. They also need historical information and lessons learned from similar projects. The only item that the sponsor does not need to know at this stage is the detailed project scope statement.

Submit
90. El comprador y el vendedor han celebrado un acuerdo formal por escrito. Para que este documento sea considerado un contrato legal debe incluir los siguientes elementos a EXCEPCIÓN de:

Explanation

The given answer, "Negociación", is incorrect. In order for a written agreement to be considered a legal contract, it must include the following elements: capacity or willingness of the parties, consideration or purpose, and lawful object. Negotiation is an essential part of reaching an agreement, so it should be included in the contract. Therefore, the correct answer should be "No exception".

Submit
91. Usted está trabajando como director de proyecto en una mina a cielo abierto que produce diamantes. En este proyecto hay cientos de interesados con intereses contrapuestos y la eficiencia con la que gestione a estos grupos de interés será la clave para un proyecto exitoso. ¿Cuál de los ítems a continuación NO es necesario para la gestión de los interesados?

Explanation

The correct answer is "Dar a cada grupo de interés lo que solicitan" (Giving each stakeholder group what they request). While it is important to identify stakeholders, determine their expectations and needs, and have effective communication with them, it is not always feasible or advisable to give each stakeholder group exactly what they request. Stakeholder management involves balancing the interests and needs of different groups, prioritizing resources, and making decisions that align with project objectives and constraints.

Submit

92. Según la siguiente matriz de riesgo probabilidad-impacto con celdas en blanco que usted debería completar, señale la respuesta CORRECTA:

Explanation

A risk with a probability of "A" and an impact of "M" will have a medium priority because it falls in the middle of the risk matrix. The risk matrix assigns priorities based on the combination of probability and impact, with higher scores indicating higher priorities. In this case, "A" represents a moderate probability and "M" represents a moderate impact, resulting in a medium priority.

Submit
93. Al momento de planificar la tecnología apropiada para realizar las comunicaciones de un proyecto para la reforma del Estado, lo MENOS importante a considerar debería ser:

Explanation

The least important factor to consider when planning the appropriate technology for project communications for State reform should be meetings for review. While meetings are important for collaboration and progress updates, they are not directly related to the technology used for communications. Factors such as the current availability of technology, the competencies of the personnel, and the work environment are more directly relevant to determining the appropriate technology for project communications.

Submit
94. Un director de proyectos investiga las causas por las cuales varias actividades no se han realizado cuando deberían haberlo hecho. El director se basa en un informe que le entregó su equipo de trabajo con las tendencias del proyecto. ¿Cuál podría ser el indicador que está utilizando el director del proyecto para investigar esta situación?

Explanation

The director of the project is using the schedule performance index (SPI) of 0.95 as an indicator to investigate the situation. The SPI compares the actual progress of the project to the planned progress, indicating whether the project is ahead or behind schedule. A value of 0.95 suggests that the project is slightly behind schedule. By investigating the causes for the activities not being completed on time, the director can identify any issues or delays that need to be addressed in order to bring the project back on track.

Submit
95. Un proyecto requiere de una inversión inicial de $500.000 y comenzará a dar beneficios netos positivos a partir del mes próximo. El primer mes los beneficios netos ascienden a $20.000, el segundo mes ascienden a $30.000 y a partir del tercer mes serán de $50.000 mensuales. ¿En cuántos meses será el período de repago de este proyecto?

Explanation

The initial investment of $500,000 will be repaid when the cumulative net benefits exceed the initial investment. In the first month, the net benefits are $20,000, in the second month they are $30,000, and from the third month onwards they are $50,000 per month. To calculate the cumulative net benefits, we add up the net benefits for each month. After 10 months, the cumulative net benefits would be $20,000 + $30,000 + ($50,000 x 8) = $440,000, which is still less than the initial investment. However, after 11 months, the cumulative net benefits would be $20,000 + $30,000 + ($50,000 x 9) = $490,000, which exceeds the initial investment. Therefore, the repayment period for this project is 11 months.

Submit
96. Durante la gestión del alcance de un proyecto para instalar fibra óptica en un edificio de departamentos, el director del proyecto debería estar involucrado en los siguientes procesos:

Explanation

The director of the project should be involved in the following processes during the scope management of a project to install fiber optic in an apartment building: planning, collecting requirements, defining the scope, creating the Work Breakdown Structure (EDT), validating the scope, and controlling the scope.

Submit
97. Deming es conocido por sus 14 pasos para la gestión de la calidad total. Este enfoque está alineado con los procesos de gestión de calidad del Project Management Institute ¿Cuál de los siguientes ítems NO forma parte del enfoque de la gestión de la calidad total de Deming?

Explanation

Deming's 14 steps for total quality management emphasize continuous improvement, teamwork, and eliminating arbitrary numerical goals for employees. The use of statistical theory for quality control is a key component of Deming's approach and is therefore not excluded from his total quality management framework.

Submit
98. Una empresa multinacional orientada por proyectos, cuenta con una oficina de gestión de proyectos (PMO). A su vez su portafolio de proyectos está ordenado por programas, proyectos y sub-proyectos. ¿Cuál de los siguientes ítems por lo general NO es un rol de la PMO?

Explanation

La PMO generalmente no es responsable de asignar los fondos para comenzar con los proyectos estratégicos. Esta función suele recaer en el área financiera o en la alta dirección de la empresa. La PMO se encarga principalmente de proveer metodologías de dirección de proyectos, asignar directores de proyectos y brindar soporte para gestionar proyectos a la organización.

Submit
99. En un proyecto para la elaboración de bio-gas utilizando los excrementos de gallinas, el equipo está planificando cuántas naves deberá construir y cómo integrará el proyecto con la producción de alimentos. ¿Cuál será el proceso MENOS utilizado?

Explanation

The process of developing the team is the least used in the project for the production of bio-gas using chicken manure. This means that the team members are not given much importance or attention in the planning and execution of the project. The focus is more on creating the work breakdown structure, collecting requirements from stakeholders, and performing quantitative risk analysis.

Submit
100. Germán es el director del proyecto de instalación de una oficina administrativa en el centro de la ciudad y quiere que algún proveedor le ofrezca un precio para realizar todo el trabajo que le ha detallado. ¿Qué tipo de documento está buscando Germán?

Explanation

Germán is looking for an "Invitación a Licitación" because he wants a supplier to offer a price for the detailed work of installing an administrative office in the city center. An "Invitación a Licitación" is a document that invites potential suppliers to submit their bids for a project. It outlines the project requirements, specifications, and terms, allowing suppliers to understand the scope of work and provide their proposed prices. Germán needs this document to gather competitive bids and select the most suitable supplier for the project.

Submit
101. En un proyecto hemos re-planificado el cronograma de tal forma de poder utilizar la misma cantidad de recursos todos los meses. Esto sería un ejemplo de ________

Explanation

In the given scenario, the project schedule has been adjusted in such a way that the same amount of resources can be used every month. This is an example of "nivelación" or "leveling" in project management. Nivelación refers to the process of smoothing out the resource utilization over the project duration to avoid resource overloads or underutilization. This helps in maintaining a consistent resource allocation throughout the project.

Submit
102. Un proyecto de telefonía satelital tiene un 80% de avance y se estima su finalización en los próximos meses. Usted está realizando una revisión estructurada e independiente para determinar si las actividades del proyecto cumplen con las políticas, los procesos y los procedimientos. ¿Qué es lo que está realizando?

Explanation

The explanation for the correct answer, "Auditoria de Calidad" (Quality Audit), is that the individual is conducting a structured and independent review to determine if the project activities comply with policies, processes, and procedures. A quality audit is specifically designed to assess the effectiveness of these processes and identify any areas for improvement. It is a systematic examination of the project's quality management system to ensure that it meets the required standards and objectives.

Submit
103. En tu proyecto de desarrollo e implementación de una interface web han implementado un sistema para controlar los factores que producen cambios, a fin de asegurarse que esos cambios sean beneficiosos y gestionar solamente los cambios aprobados. ¿Cuál será el principal resultado de ese sistema?

Explanation

The main result of implementing the system for controlling factors that produce changes in a web interface project is the approval of corrective actions. This system ensures that changes are beneficial and only approved changes are managed, which helps in identifying and implementing corrective actions to address any issues or problems that may arise during the development and implementation process.

Submit
104. El proyecto Caratriste que le han asignado no se parece a ningún otro proyecto en el que haya trabajado la empresa previamente. Los recursos utilizados en este proyecto son muy demandados en otros proyectos de la empresa. El plazo de finalización de Caratriste definido por el patrocinador es muy exigente. A los fines de cumplir con el cronograma y los costos, hubo algunos entregables a los cuáles no se les alcanzó a hacer las inspecciones de calidad antes de enviar al cliente. Luego de los reclamos del cliente por algunos productos defectuosos, hubo varios trabajos que se volvieron a realizar con altos costos asociados. ¿Por qué ocurrieron estos problemas?

Explanation

The problems occurred due to poor risk identification. The project, Caratriste, was unlike any previous project the company had worked on, and the resources used were in high demand for other projects. The tight deadline set by the sponsor led to some deliverables being sent to the client without undergoing quality inspections. As a result, the client complained about defective products, leading to costly rework. This indicates that the risks associated with rushing the project and not ensuring proper quality control were not adequately identified and addressed in advance.

Submit
105. En el proyecto para la puesta en marcha de un nuevo hotel, ya han finalizado con la planificación de riesgos. ¿Cuál de los siguientes enunciados NO es un resultado del plan de respuesta al riesgo?

Explanation

The plan de respuesta al riesgo, or risk response plan, includes identifying, analyzing, and prioritizing risks, as well as developing strategies to mitigate or respond to them. One of the results of this plan is grouping risks by categories, which helps to organize and prioritize them based on their similarities. This allows for a more efficient and effective approach to managing and addressing the identified risks. Therefore, "Riesgos agrupados por categorías" is not a result of the risk response plan.

Submit
106. El gerente general de tu empresa de desarrollo de combustibles alternativos quiere que todos los meses le mandes el informe de avance del proyecto. ¿Qué tipo de diagrama deberías enviarle?

Explanation

Para enviarle al gerente general un informe de avance del proyecto, deberías enviarle un diagrama de hitos. Este tipo de diagrama muestra los eventos o hitos clave del proyecto en una línea de tiempo, lo que permite al gerente tener una visión general de los principales logros y fechas importantes del proyecto. Esto le proporcionará una forma clara y concisa de evaluar el progreso del proyecto y tomar decisiones basadas en la información proporcionada.

Submit
107. Una de las herramientas al momento de solicitar respuesta de los vendedores del proyecto es la conferencia de oferentes. Estas conferencias podrían tener un efecto perjudicial para el proyecto si el director del mismo no se asegura que __________

Explanation

If the project director ensures that all questions and answers are put in writing and sent to all bidders, it minimizes the risk of harmful effects on the project during the bidder conference. This approach promotes transparency, fairness, and equal access to information for all bidders. It ensures that all bidders have the same understanding of the project requirements and can make informed decisions when submitting their proposals. By providing written documentation to all bidders, the project director eliminates any potential bias or favoritism that could arise from individual meetings or selective sharing of information.

Submit
108. Su proyecto está atravesando por varios conflictos entre los interesados. Usted se está comunicando con ellos y registra todos los incidentes que ocurren en una planilla, pero tiene la sensación de que algo le está faltando para poder realizar esto de manera más ordenada. ¿Qué podría estar faltando?

Explanation

Based on the given scenario, the project is experiencing conflicts among stakeholders, and the person is communicating with them and recording all the incidents in a spreadsheet. However, they feel that something is missing to make this process more organized. The missing element could be a "Registro de cambios" or a change log. This would allow them to document and track any changes made during the project, providing a clear record of modifications and helping to manage and resolve conflicts effectively.

Submit
109. En una reunión de avance de un proyecto de forestación, se están planteando varios temas al mismo tiempo. Además, hay algunos miembros claves del equipo que no están participando de la reunión. ¿Qué debería haber realizado el director del proyecto para una reunión efectiva?

Explanation

The director of the project should have published an agenda and a set of rules to control the meeting. This would ensure that everyone is aware of the topics being discussed and the expectations for participation. It would also help to keep the meeting organized and focused, especially with multiple topics being discussed at the same time. Additionally, by not having key team members present, the director could use the agenda and rules to communicate the important information and decisions made during the meeting to those who were unable to attend.

Submit
110. Eres director de un programa para el desarrollo productivo de una Ciudad. Hace doce meses que estás coordinando este programa cuando uno de los directores de proyecto realiza un descubrimiento muy importante que podría mejorar la forma de trabajo del resto de los proyectos. ¿Qué es lo primero que deberías hacer?

Explanation

The first thing you should do is ensure that the discovery is communicated to the other project directors in the meeting next week. This is important because it allows for immediate sharing of the important information and ensures that all the directors are aware of the potential improvement. By sharing the discovery with the other directors, it promotes collaboration and the possibility of implementing the improvement across all projects.

Submit
111. Tu proyecto sobre la puesta en marcha de una planta de reciclaje de residuos ha llegado a su fin. En el informe de lecciones aprendidas están comentando sobre la utilidad de haber desarrollado una estructura de desglose del trabajo (EDT). ¿Cuál de estos enunciados suele ser el que MENOS apoyo requiera de la EDT?

Explanation

The least supported statement by the Work Breakdown Structure (WBS) is the "Plan de adquisiciones" or the procurement plan. The WBS is a hierarchical breakdown of the project's scope into smaller, more manageable components. It helps in organizing and defining the work required for the project. While estimating costs, planning resources, and developing the schedule are all essential components of the project that can be easily broken down and managed with the help of a WBS, the procurement plan is a separate process that focuses on acquiring the necessary resources, goods, or services from external sources. It may not necessarily be directly tied to the WBS.

Submit
112. Eres el director de un proyecto que involucra un equipo multidisciplinario con personas de distintas nacionalidades. Cuando llegas a la reunión de avance semanal te das cuenta que un grupo de personas se están riendo por la vestimenta que utiliza un nuevo miembro del equipo de un país lejano. ¿Qué es lo MEJOR que puedes hacer?

Explanation

The best thing to do in this situation is to start the team meeting with a brief introduction about respecting different religions, fashion, and personal integrity. This will address the issue of the team members laughing at the new member's attire and promote a culture of inclusivity and respect within the team. By addressing the incident and setting the tone for the meeting, it shows that such behavior is not acceptable and encourages a more positive and inclusive environment for everyone involved.

Submit
113. ¿Quién será el responsable de la calidad en un proyecto de producción en serie?

Explanation

In a project of production in series, the responsibility for quality lies with the director of the project. The director is ultimately responsible for ensuring that the project meets the required quality standards. They oversee the entire project and have the authority to make decisions and implement measures to ensure quality control. The gerente de asegurar la calidad (quality assurance manager) and gerente de control de calidad (quality control manager) may play a role in implementing quality measures, but the ultimate responsibility lies with the director of the project. The team of the project also contributes to ensuring quality, but they work under the direction and guidance of the project director.

Submit
114. Según los datos de la tabla a continuación, ¿Cuál es el valor monetario esperado?

Explanation

Based on the data provided in the table, the value of 1520 is the expected monetary value.

Submit
115. La PRINCIPAL clave para el éxito de un proyecto se da cuando:

Explanation

The main key to the success of a project is when there is a good connection between the business strategy and the project deliverables. This means that the project is aligned with the overall goals and objectives of the organization, ensuring that the project outcomes will contribute to the strategic direction of the business. This connection helps to prioritize and focus efforts, ensuring that resources are used effectively and that the project's outcomes are valuable and relevant to the organization.

Submit
116. Una empresa trabaja bajo una estructura matricial débil. El director del proyecto no logra que los miembros del equipo se comprometan con el proyecto. ¿Cuál sería el mejor tipo de autoridad para mejorar este problema?

Explanation

In a weak matrix structure, the project manager does not have direct authority over the team members. Therefore, the best type of authority to improve the problem of team members not being committed to the project would be "Experto" (Expert). This means that the project manager should rely on their expertise and knowledge in the subject matter to influence and gain the commitment of team members. By demonstrating their expertise and providing guidance, the project manager can inspire confidence and encourage team members to actively engage and commit to the project.

Submit
117. Usted es el director de un proyecto para la puesta en marcha de una planta que fabricará botellas de plástico para bebidas gaseosas. Por lo general, ¿Cuál será el estilo de liderazgo que debería aplicar durante las fases iniciales de ese proyecto?

Explanation

The correct answer is "Directivo". In the initial phases of a project to set up a plant for manufacturing plastic bottles for carbonated beverages, a directive leadership style would be most appropriate. As the project director, this style of leadership involves providing clear instructions, making decisions independently, and taking charge of the project's direction. This leadership style ensures efficient decision-making and effective coordination of tasks, which is crucial during the project's early stages.

Submit
118. En un proyecto de desarrollo inmobiliario de $23 millones y una duración de 18 meses, el plan del proyecto ya ha sido desarrollado y aprobado por los interesados. Luego, el Cliente solicita que se agregue un cambio en el proyecto sin retrasar la fecha estimada de entrega. El cliente está dispuesto a pagar más por este cambio. ¿Qué es lo primero que debería hacer el director del proyecto?

Explanation

The first thing the project manager should do is to start the process of integrated change control. This involves evaluating the requested change, determining its impact on the project's scope, schedule, and budget, and making a decision on whether to approve or reject the change. By following the integrated change control process, the project manager can ensure that any changes made to the project are properly evaluated and managed, minimizing the risk of delays or cost overruns.

Submit
119. En la dirección de un proyecto para la construcción de un Hotel para turistas de altos ingresos, serán necesarios varios contratistas externos. Durante el proceso de planificación de las contrataciones, se incluye el enunciado del alcance del trabajo en uno de los contratos con un vendedor. El PRINCIPAL motivo para la inclusión de esto en el contrato será:

Explanation

The main reason for including the statement of work in the contract is to ensure that the vendor clearly understands what the organization is requesting. By including the necessary items, the organization can effectively communicate its requirements and expectations to the vendor, minimizing the risk of misunderstandings or misinterpretations. This helps to establish a clear understanding of the scope of work and ensures that the vendor delivers the desired results.

Submit
120. Durante la ejecución de un proyecto, el Cliente solicita un cambio en el alcance. El director del proyecto evalúa el impacto de este cambio y busca alternativas para su implementación. Luego le envía un informe al Cliente informando los impactos de ese cambio. ¿Sobre qué restricciones habrá evaluado el impacto el DP?

Explanation

Durante la evaluación del impacto del cambio solicitado por el Cliente, el director del proyecto habrá evaluado las restricciones de alcance, tiempo, costo, calidad, recursos y riesgos. Estas restricciones son fundamentales para determinar cómo el cambio afectará a cada una de estas áreas y si es viable implementarlo dentro de los límites establecidos. La evaluación de estas restricciones permite al director del proyecto identificar posibles implicaciones y buscar alternativas para su implementación.

Submit
121. En el informe de cierre del proyecto, el gerente de la PMO le solicita un informe histórico que incluya el histograma de recursos humanos. ¿Qué indica este diagrama?

Explanation

This diagram indicates the utilization of resources over time. It provides information on how resources have been allocated and used throughout the duration of the project. It helps to track and analyze the efficiency and effectiveness of resource allocation, identify any bottlenecks or areas of improvement, and make informed decisions for future resource planning.

Submit
122. Eres el director de un proyecto de construcción de un centro comercial. El SV indica un valor de -$50.000. Luego de una reunión con tu equipo del proyecto, deciden en conjunto trabajar horas extras para ejecutar en forma acelerada algunas tareas. De esta forma el proyecto volverá a un índice de desempeño del cronograma de 1 en un plazo de 15 días. Mañana tienes la reunión de estado de avance del proyecto con el patrocinador y el cliente. ¿Qué deberías informar en esa reunión?

Explanation

The correct answer states that the project is delayed, but the team will implement measures to bring it back to the budgeted values in the next 15 days. This means that although the project is currently behind schedule, the team is taking proactive steps to address the delay and ensure that it aligns with the planned timeline and budget in the near future.

Submit
123. ¿Con qué herramienta se examina la efectividad de las estrategias de respuesta al riesgo durante la fase de monitoreo?

Explanation

Las auditorías de los riesgos se utilizan para examinar la efectividad de las estrategias de respuesta al riesgo durante la fase de monitoreo. A través de las auditorías, se evalúa si las estrategias implementadas están siendo efectivas para mitigar los riesgos identificados. Esto implica revisar y evaluar la implementación de las estrategias, identificar posibles brechas o áreas de mejora, y realizar ajustes si es necesario. Las auditorías de riesgos ayudan a garantizar que las estrategias de respuesta estén siendo adecuadas y eficientes en la gestión de los riesgos.

Submit
124. Estas evaluando un proyecto de exportación de frutas. Existen tres variedades de frutas. En la tabla a continuación, se resume el flujo de fondos de cada una de esas variedades. Si el costo del capital del dinero es del 10% anual, ¿Qué variedad es la más conveniente?

Explanation

The correct answer is Proyecto A because it has the highest net present value (NPV) compared to the other projects. The NPV takes into account the cash flows of each project and discounts them back to the present value using the cost of capital. Since the cost of capital is 10% annually, the project with the highest NPV indicates that it generates the highest return on investment and is the most profitable option among the three varieties of fruits.

Submit
125. Se está trabajando en un proyecto para planificar el layout de una fábrica de productos súper congelados gourmet. Para poder llevar a cabo ciertas actividades de este proyecto es necesario que el Cliente provea las especificaciones técnicas de las maquinarias importadas, pero esta información no estará disponible hasta dentro de 20 días. Esto sería un ejemplo de:

Explanation

This scenario represents a restriction because it involves a limitation or constraint that affects the project. The project team needs the technical specifications of the imported machinery, but they cannot proceed with certain activities until the client provides this information, which will only be available in 20 days. This restriction hinders the progress of the project and imposes a limitation on the team's ability to plan and carry out their tasks.

Submit
126. La alta gerencia está evaluando distintos proyectos de inversión. Entre las herramientas para la selección, están utilizando el método de medición de beneficios. ¿Cuál de los siguientes ítems NO es un ejemplo de este método?

Explanation

The method of benefit measurement focuses on evaluating the benefits of different investment projects. Models of rating, contribution of benefits, and economic models are all examples of this method as they involve assessing and measuring the potential benefits of the projects. However, linear programming is not directly related to measuring benefits. It is a mathematical optimization technique used to determine the best outcome in a given mathematical model, typically involving constraints and objectives. Therefore, programación lineal is not an example of the method of benefit measurement.

Submit
127. Marcela está controlando su proyecto con revisiones retrospectivas para registrar las lecciones aprendidas y de esa forma mejorar los procesos que sean necesarios. ¿Cuál de los siguientes ítems NO debería escribir Marcela en el reporte de lecciones aprendidas durante la revisión del proyecto?

Explanation

Marcela should not write the names and surnames of the people who performed poorly in their tasks in the lessons learned report during the project review. This is because the purpose of the report is to focus on improving processes and learning from mistakes, rather than singling out individuals. Including this information could create a negative and demotivating environment, which is counterproductive to the goal of improving the project.

Submit
128. Eres el director de proyecto y estás trabajando con siete interesados en la etapa de planificación. Durante la ejecución del proyecto se incorporan cinco nuevos interesados. ¿Cuántos canales de comunicación se agregaron al proyecto?

Explanation

During the planning stage, there were 7 stakeholders involved, which means there were 7 communication channels. When 5 new stakeholders were added during the project execution, each of them would need to communicate with the existing 7 stakeholders, resulting in 5 new communication channels for each of them. Therefore, the total number of new communication channels added to the project would be 5 multiplied by 7, which equals 35. Adding this to the initial 7 communication channels gives us a total of 42. However, we also need to consider the communication channels between the new stakeholders themselves, which would be 5 multiplied by (5-1)/2, resulting in 10 additional channels. Adding these 10 channels to the previous total of 42 gives us a final answer of 52, which is closest to the given answer of 50.

Submit
129. Usted está trabajando como director de un proyecto de forestación que requerirá un gran número de trabajadores. Durante el proceso de planificación de los recursos, obtiene la matriz de asignación de responsabilidades (RAM). ¿Cuál es la utilidad principal de la matriz RAM?

Explanation

The main utility of the Responsibility Assignment Matrix (RAM) is to ensure that all team members understand their roles within the project. The RAM provides a clear and visual representation of the responsibilities and tasks assigned to each team member, allowing them to have a comprehensive understanding of their role and how it fits into the overall project. This helps to avoid confusion or misunderstandings among team members and ensures that everyone is on the same page in terms of their responsibilities.

Submit
130. Luego de 10 meses de trabajo en tu proyecto has llegado a la fase de cierre. Cuál de las siguientes acciones será lo que te lleve MENOS tiempo:

Explanation

Establecer las métricas de calidad será lo que te lleve MENOS tiempo porque implica definir los parámetros y estándares que se utilizarán para evaluar la calidad del proyecto. Este proceso generalmente implica establecer criterios y medidas específicas, lo cual puede ser más rápido de hacer en comparación con actualizar los procesos y procedimientos, agregar nuevas habilidades a los registros personales o documentar las lecciones aprendidas, que pueden requerir más tiempo y esfuerzo.

Submit
131. Un proyecto está en su etapa de ejecución y un grupo de interesados aprueban formalmente un cambio. Si usted fuera el director de ese proyecto, ¿Qué necesitaría para evaluar el impacto de ese cambio sobre el proyecto?

Explanation

To evaluate the impact of the approved change on the project, the project manager would need to assess the project's performance. This involves analyzing the progress, efficiency, and effectiveness of the project in relation to its objectives and deliverables. By evaluating the project's performance, the project manager can determine how the approved change will affect various aspects such as timelines, resources, costs, and overall project success. This assessment will help in making informed decisions and adjustments to ensure the project continues to meet its goals and objectives.

Submit
132. Usted está trabajando en conjunto con el analista de negocios para identificar los principales entregables necesarios para cumplir con los objetivos del proyecto. Luego de una reunión con el patrocinador, ya han escrito los requisitos del negocio y sus principales atributos. ¿Cuál será el próximo paso?

Explanation

The next step would be to define the requirements traceability matrix. This matrix helps to establish the relationship between the project's objectives and the identified business requirements. It allows for tracking and managing the progress of each requirement throughout the project lifecycle. By defining the matrix, the project team can ensure that all requirements are addressed and met, and also helps in identifying any gaps or inconsistencies in the requirements.

Submit
133. Las siguientes herramientas se utilizan para armar el cronograma del proyecto. Pero sólo una de ellas incluye análisis de riesgo en las estimaciones. ¿Cuál?

Explanation

The correct answer is PERT (Técnica de evaluación y revisión de programas). PERT is a project management tool that includes risk analysis in estimations. It helps in identifying and analyzing potential risks and uncertainties in a project schedule, allowing for more accurate planning and decision-making. PERT uses three estimates for each activity: optimistic, pessimistic, and most likely, to calculate the expected duration of the project and determine the critical path. By incorporating risk analysis, PERT helps project managers to account for uncertainties and make informed decisions to ensure successful project completion.

Submit
134. En un proyecto para abrir una empresa de mensajería, se ha realizado un plan de gestión de los riesgos. Este plan forma parte del plan para la dirección del proyecto. ¿Cuál de los siguientes ítems NO forma parte del plan de gestión de riesgos? Cómo estructurar y desarrollar _________

Explanation

El plan de gestión de riesgos incluye la identificación de riesgos, el análisis cualitativo y cuantitativo de riesgos, y el plan de respuesta al riesgo. Sin embargo, los riesgos secundarios y residuales no forman parte del plan de gestión de riesgos. Los riesgos secundarios se refieren a los riesgos que pueden surgir como consecuencia de la implementación de las respuestas a los riesgos identificados, mientras que los riesgos residuales son aquellos riesgos que quedan después de que se hayan implementado todas las respuestas planificadas. Estos elementos son parte del proceso de gestión de riesgos en general, pero no están incluidos en el plan de gestión de riesgos específicamente.

Submit
135. Fuiste el director del proyecto para la instalación de 25 computadoras en un organismo de gobierno. El proyecto ha finalizado y el Cliente aceptó formalmente los entregables acorde a los términos de referencia del contrato. Otra empresa encargada de instalar el software en esas computadoras te ha incluido a ti en su cronograma de actividades para que colabores durante el proceso de instalación. ¿Qué deberías hacer?

Explanation

You should clarify to the vendor that you have already closed the project according to the scope and cannot collaborate on this new project without a contractual agreement.

Submit
136. En un proyecto de varias fases, durante cada etapa de control existen dos procesos que se realizan en paralelo para asegurar la aceptación del trabajo realizado y que se encuentre bien realizado. ¿Cuáles son estos dos procesos?

Explanation

During each control phase of a multi-phase project, there are two parallel processes that are carried out to ensure the acceptance and quality of the work done. These processes are validating the scope and controlling the quality.

Submit
137. Un terremoto dañó las bases de datos de una Compañía de Seguros Internacional. ¿Qué debería utilizar el director del proyecto para mitigar los daños de ese siniestro?

Explanation

The director of the project should utilize the "Reserva de gestión" to mitigate the damages caused by the earthquake. This refers to a management reserve, which is a portion of the project budget set aside to address unforeseen events or risks that may impact the project. In this case, the earthquake has caused damage to the company's databases, and the management reserve can be used to cover the costs of repairing or recovering the databases, ensuring that the project can continue without significant disruptions.

Submit
138. El proyecto está llegando a su fin y el equipo de trabajo está muy ansioso y un tanto preocupado. ¿En qué tipo de organización seguramente están trabajando?

Explanation

The team is described as anxious and somewhat worried, which suggests that they are working in a project-oriented organization. In project-oriented organizations, teams are focused on completing specific projects and there is often a sense of urgency and pressure to meet project deadlines. This aligns with the team's current state of anxiety and concern as the project is nearing its end.

Submit

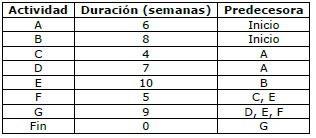

139. Según la información de la siguiente tabla, conteste las 5 preguntas siguientes. ¿Cuántas semanas dura el proyecto?

Explanation

Based on the information provided in the table, the duration of the project is 32 weeks.

Submit
140. ¿Cuál es la ruta crítica?

Explanation

The critical path is the longest path in a project network diagram that determines the minimum amount of time needed to complete the project. In this case, the path B-E-F-G is the longest path as it includes all the activities B, E, F, and G. Therefore, B-E-F-G is the critical path.

Submit
141. Si la actividad C cambia de 4 semanas a 11 semanas ¿Cuál sería la ruta crítica cercano?

Explanation

If the activity C changes from 4 weeks to 11 weeks, the new critical path would be A-C-F-G. This is because the critical path is the longest path in a project, and it is determined by the activities that have the longest duration. Since activity C now has a longer duration, it becomes part of the critical path, along with activities F and G. Activities A and B remain on the critical path as they are still required to be completed before the other activities.

Submit
142. ¿Cuál es la holgura libre en semanas de la actividad D?

Explanation

The free slack or float of an activity is the amount of time that an activity can be delayed without delaying the project. In this case, the activity D has a free slack of 10 weeks, which means it can be delayed by up to 10 weeks without affecting the overall project timeline.

Submit
143. ¿Qué ocurre con el proyecto si la actividad D demora 10 semanas más de lo planificado?

Explanation

Si la actividad D demora 10 semanas más de lo planificado, esto incrementa el riesgo del proyecto. Esto se debe a que cualquier retraso en una actividad puede tener un efecto en cadena en otras actividades y en el cronograma general del proyecto. Un retraso en la actividad D puede causar retrasos en las actividades que dependen de ella, lo que a su vez puede llevar a un retraso en la finalización del proyecto. Por lo tanto, el riesgo de que el proyecto no se complete a tiempo se incrementa.

Submit
144. En su empresa contrataron a Rubén Peuchene para la capacitación del examen PMP®. Este facilitador no cumplió con las expectativas de los participantes. Por lo tanto, el gerente de recursos humanos implementó el plan de respuesta al riesgo y decidió cambiar a este facilitador por otro capacitador pre-calificado en la lista de posibles vendedores. La próxima capacitación en este tema la va a dictar la facilitadora Lucila Pierna en otra de las sucursales de esta Compañía. Lucila está cumpliendo con el alcance de lo pactado mucho mejor que Rubén. Sin embargo, todavía quedan algunos puntos del contrato sin cubrir de manera adecuada por Lucila. ¿Qué es lo que explica esta situación?

Explanation

The situation can be explained by the presence of residual risks. Despite the change in facilitators and the improved performance of Lucila Pierna, there are still some aspects of the contract that are not adequately covered. These remaining issues can be attributed to the residual risks, which are the risks that remain even after implementing the response plan. This suggests that there were some unforeseen or uncontrollable factors that have affected the successful completion of the contract.

Submit

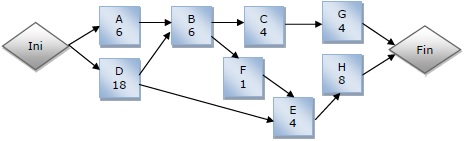

145. En el siguiente diagrama, las letras indican actividad y los números la duración en días. ¿Cuál es la holgura de la ruta F-G-H-I?

Explanation

The diagram represents a project schedule with activities labeled as letters and their durations as numbers. The question asks for the slack or float of the path F-G-H-I. Slack or float is the amount of time an activity can be delayed without delaying the project. In this case, the path F-G-H-I has a duration of 15 days. The critical path, which is the longest path in the project, is F-G-H-I. Therefore, there is no slack or float on this path, and any delay in any of these activities will delay the project.

Submit
146. En un proyecto de 400 días de duración, el equipo de proyecto necesita acortar la ruta crítica en 115 días. Para ello, podrán realizar las siguientes acciones a EXCEPCIÓN de:

Explanation

Eliminar holguras (Eliminating slack) is not a valid action to shorten the critical path in a project. Slack or float is the amount of time that an activity can be delayed without delaying the project. By eliminating slack, the project timeline would become more rigid and any delay in any activity would directly impact the overall project duration. The other actions mentioned, such as compression, parallel activities, and re-planning, are valid methods to shorten the critical path and reduce project duration.

Submit
147. Usted está trabajando como director de proyecto con metodologías ágiles, en una empresa de desarrollo de hardware en un mercado muy cambiante. En los últimos 6 meses sus competidores han diseñado 8 nuevos productos de hardware similares a los que desarrolla su empresa. Además, el cliente generalmente no compra un modelo anticuado a menos que se lo dejen a un precio insignificante. En el próximo proyecto de desarrollo de software, la clave del éxito será que el equipo tenga gran flexibilidad para ir adaptando el plan a las necesidades del mercado. ¿Cuál será el MEJOR enfoque para llevar a cabo el cronograma de este proyecto?

Explanation

The best approach for carrying out the schedule of this project would be a gradual planning. Given the rapidly changing market and the competition's ability to quickly design and release new products, it is crucial for the team to have flexibility in adapting the plan to market needs. Gradual planning allows for continuous adjustments and iterations, ensuring that the project stays aligned with market demands and increases the chances of success. This approach allows the team to respond quickly to changes and make necessary adjustments to the project plan as needed.

Submit
148. Luego de varias iteraciones finalmente el equipo de proyecto ha finalizado la planificación de un proyecto para la provisión de servicios eléctricos, con un buen nivel de detalle como para comenzar con la etapa de ejecución. ¿Cuál de los siguientes ítems será lo que MÁS realice mientras esté dirigiendo y gestionando el proyecto?

Explanation

While directing and managing the project, the most important task would be to request changes. This is because during the execution phase, there may arise situations or circumstances that require modifications to the original plan. By requesting changes, the project manager ensures that any necessary adjustments are made in order to keep the project on track and achieve its objectives. This task is crucial for maintaining project efficiency and addressing any unforeseen issues that may arise.

Submit
149. Si quieres estimar con un buen nivel de precisión los costos del proyecto, lo más apropiado sería utilizar una técnica de estimación:

Explanation

The most appropriate technique for estimating project costs with a good level of precision is "De abajo hacia arriba" which means "Bottom-up" estimation. This technique involves breaking down the project into smaller tasks and estimating the cost of each individual task. These individual estimates are then aggregated to calculate the total project cost. This approach is considered more accurate as it takes into account the specific requirements and details of each task, resulting in a more precise cost estimation.

Submit
150. Usted debe realizar las estimaciones de costo del proyecto lo más rápido posible. Para ello le comunica al patrocinador que va a utilizar una técnica de estimación análoga, poco precisa, pero que cumplirá con la restricción del plazo. Esta técnica de estimación es equivalente a una estimación:

Explanation

The explanation for the correct answer "De arriba hacia abajo" is that this technique is commonly known as top-down estimation. It involves making high-level estimates based on a limited amount of information or a rough understanding of the project. This approach allows for quick estimation but may not be very accurate. By using this technique, the project manager can fulfill the time constraint of providing cost estimates as quickly as possible.

Submit
151. Eres un PMP® certificado y estás como director de un proyecto muy grande. Este proyecto no se ha realizado nunca en el pasado, por lo que los procesos de dirección profesional de proyectos serán muy importantes. Dentro de tus responsabilidades profesionales deberías aplicar los procesos correctos. Tú deberías asegurar que los siguientes ítems formen parte de ese proyecto, a EXCEPCIÓN de:

Explanation

not-available-via-ai

Submit
152. Usted quiere identificar y documentar en su proyecto las características funcionales y físicas del producto. ¿Cuál es la principal herramienta que debería utilizar?

Explanation

The main tool that should be used to identify and document the functional and physical characteristics of the product is a System of Configuration Management. This tool helps in keeping track of the different versions and changes made to the product throughout its development and lifecycle. It ensures that all necessary documentation and information related to the product's configuration is properly managed and controlled. This helps in maintaining consistency, traceability, and control over the product's characteristics.

Submit
153. Uno de los miembros de tu equipo te informa que cometieron un error en una de las actividades, por lo que será imposible cumplir con la fecha del próximo hito. ¿Qué es lo MEJOR que puedes hacer como director de este proyecto?

Explanation

As the director of the project, the best thing to do in this situation is to develop alternatives to meet the milestone deadline. Changing the milestone date may not be feasible or desirable, as it could disrupt other project dependencies. Applying punishments to the team members involved in the error may create a negative work environment and discourage open communication about mistakes. Instead, it is more effective to gather the team, identify the root cause of the error, and brainstorm solutions to overcome the setback and meet the milestone deadline.

Submit
154. Un proyecto tiene un costo estimado a la finalización (BAC) de $33 millones. Al día de la fecha el proyecto está con un 30% de avance, el índice de desempeño del costo es de 0.80 y el índice de desempeño de agenda es 0.75. Para mitigar estos problemas el patrocinador le solicita al director del proyecto que mejore el plan de respuesta al riesgo y que trabaje en conjunto con las personas encargadas de implementar las estrategias derivadas de esos planes de respuesta. ¿Quiénes ejecutan los planes de respuesta al riesgo?

Explanation

The correct answer is "Dueño del riesgo". In risk management, the risk owner is responsible for executing the risk response plans. They are the individuals or groups who have the authority and accountability to manage the risk and take necessary actions to address it. The project manager and their team may work closely with the risk owner to develop and implement the risk response plans, but ultimately it is the risk owner who executes these plans.

Submit
155. Durante la iniciación del proyecto, tres colegas amigos del director del proyecto le consultan sobre la nueva metodología de dirección de proyectos que quieren implementar en la organización. Ellos no están de acuerdo con esa metodología ya que difiere de la forma tradicional con la cual han gestionado siempre sus proyectos. ¿Qué debería hacer el director del proyecto?

Explanation

The director of the project should notify the project management office about the new methodology that his colleagues want to implement. This is because the project management office is responsible for overseeing and ensuring the successful implementation of project management methodologies within the organization. By notifying them, the director can seek their guidance and support in implementing the new methodology and address any concerns or resistance from his colleagues. This will help ensure a smooth transition and increase the chances of successful project outcomes.

Submit
156. Acabas de empezar a administrar un contrato cuando la gerencia general decide rescindirlo. ¿Qué es lo primero que deberías hacer?

Explanation

The correct answer is "Cerrar ese contrato de adquisición" which translates to "Close that procurement contract" in English. This means that the first thing you should do is to formally terminate or close the contract that you have just started managing, since the general management has decided to rescind it. This ensures that all parties involved are aware of the contract termination and any necessary steps can be taken to conclude the procurement process.

Submit
157. Tu empresa ha ganado una licitación para la construcción de una obra de revestimiento en hormigón de un canal de riego, cuyo valor es $ 1.200.000. Eres el director de proyecto en otro proyecto similar de tu empresa que está en ejecución. ¿Qué es lo primero que deberías hacer?

Explanation

The correct answer is to request information from management on how the new project will affect your current project. This is important because winning the bid for the new project means that resources, such as manpower and equipment, may need to be redirected or shared between the two projects. By understanding how the new project will impact your current project, you can properly plan and allocate resources to ensure the successful execution of both projects.

Submit
158. Durante la fase de ejecución de un proyecto de mejoras de una refinería, usted está gestionando las expectativas de los interesados en función de los lineamientos del plan de gestión de los interesados. ¿Cuál sería la forma más apropiada de mantener las relaciones con los principales interesados?

Explanation

The most appropriate way to maintain relationships with key stakeholders during the execution phase of a refinery improvement project is to first meet with each of them individually before convening a group meeting. This approach allows for personalized communication and understanding of each stakeholder's expectations and concerns before addressing them collectively. It helps in building rapport, addressing individual needs, and ensuring effective stakeholder management throughout the project.

Submit
159. Según los datos de la pregunta anterior, ¿Cuál será el costo estimado a la conclusión (EAC) si los índices de desempeño del proyecto hasta el mes 3 están afectados por problemas coyunturales que no se repetirán a futuro?

Explanation

The estimated cost at completion (EAC) will be 570. This suggests that the project performance issues experienced in the first three months are not expected to recur in the future. Therefore, the cost estimate for the completion of the project remains at 570.

Submit
160. Su organización está orientada a proyectos de desarrollo de proyectos de innovación y está aplicando herramientas de gestión de proyectos con ciclos de vida iterativos. ¿En qué grupo de procesos se llevan a cabo las lecciones aprendidas para la mejora continua?

Explanation

In the group of processes called "Monitoreo y control" is where the lessons learned for continuous improvement are carried out. This group of processes focuses on monitoring project progress, comparing it to the project management plan, and taking corrective actions as necessary. It involves activities such as monitoring project activities, tracking project risks, and controlling changes. The lessons learned process is an important part of this group as it allows the organization to reflect on past experiences, identify what worked well and what didn't, and apply those lessons to future projects for continuous improvement.

Submit
161. En un proyecto para la construcción de un astillero, ¿Cuál de los siguientes ítems necesita para comenzar a controlar el alcance del proyecto?

Explanation

To begin controlling the scope of a project for the construction of a shipyard, one needs performance data. Performance data provides information on how the project is progressing and allows for tracking and monitoring of the project's scope. It helps in identifying any deviations or variances from the planned scope and enables the project team to take appropriate corrective actions to ensure the project stays on track. This data can include metrics, measurements, and other indicators of project performance.

Submit
162. Eres el director de un proyecto y junto con tu equipo de trabajo están por finalizar con las actividades. El proyecto va a finalizar antes de lo previsto por lo que recibirás un bono de $50.000 por superar los objetivos. Todo lo pactado en el contrato con el Cliente ha sido completado perfectamente, pero descubres que el entregable podría causar daños ambientales dentro de unos años. Para solucionar este problema deben realizar algunas modificaciones al producto, por lo que el proyecto se retrasará y no cobrarás tu bono. ¿Qué es lo mejor que puedes hacer?

Explanation

The best course of action in this situation is to explain the situation to the client and seek alternative solutions. By doing so, you can address the potential environmental damage caused by the deliverable and work towards finding a resolution that mitigates these risks. This approach demonstrates transparency, responsibility, and a commitment to ethical practices, which are essential in maintaining a good relationship with the client and ensuring the long-term success and sustainability of the project.

Submit
163. Según los datos de la pregunta 99, ¿Cuál será el costo estimado hasta la conclusión (ETC), bajo el supuesto que a futuro se mantendrá un comportamiento similar del proyecto a lo que indican los índices de desempeño hasta el mes 3?

Explanation

Based on the information provided in question 99, the estimated cost to completion (ETC) will be 308. This is assuming that the project will continue to perform similarly to the performance indices up to month 3.

Submit
164. Usted lleva 25 años trabajando como líder de proyectos en una empresa transportadora de energía. Un director de proyectos de una empresa de su competencia le envía un e-mail solicitando ayuda para resolver un problema que se ha planteado en su nuevo proyecto. Usted conoce a esta persona por los congresos internacionales de gestión de proyectos y sabe que es una persona muy honesta y profesional. ¿Qué es lo MEJOR que puede hacer en este caso?

Explanation

In this scenario, the best course of action would be to inform your superior before contacting your colleague from the competing company. By doing so, you are being transparent and seeking guidance from your own company before engaging in any collaboration. This ensures that you are acting in the best interest of your company and avoiding any potential conflicts of interest. Additionally, involving your superior allows for proper communication and decision-making within the organization.

Submit
165. Durante la etapa de ejecución del proyecto el director del proyecto quiere validar que se esté cumpliendo con el alcance. ¿Qué acción deberían llevarse a cabo para esto?

Explanation

During the project execution phase, the project manager wants to validate that the scope is being met. To achieve this, the action that should be carried out is inspection. Inspection involves examining the project deliverables and comparing them to the defined scope to ensure that they align. This helps in identifying any deviations or discrepancies and allows for necessary corrective actions to be taken to ensure that the project stays on track and meets its objectives.

Submit
166. En un programa para el bien social, ya se ha definido con precisión el alcance del proyecto aunque las actividades todavía no están muy claras. Usted necesita definir las actividades del proyecto para realizar luego el cronograma. ¿Cuál de los siguientes enunciados sería lo MÁS IMPORTANTE para poder realizar esto?

Explanation

The most important statement to define the activities of the project and create a schedule would be the "Estructura de desglose del trabajo" or Work Breakdown Structure. This is a hierarchical breakdown of the project's deliverables into smaller, manageable tasks. It helps to identify all the activities that need to be done and their dependencies, allowing for a better understanding of the project scope and timeline. The other options, such as the critical path, network diagrams, and Gantt charts, are tools that can be used in conjunction with the work breakdown structure to plan and manage the project effectively.

Submit
167. Usted debe finalizar el proyecto 4 semanas antes de lo planificado. ¿Cuál de las siguientes opciones será la mejor alternativa?

Explanation

Asignar una persona experimentada en D por $5.000 para finalizar esa actividad en 14 semanas sería la mejor alternativa porque permitiría acortar la duración del proyecto en 4 semanas, cumpliendo con el objetivo de finalizar 4 semanas antes de lo planificado. Además, el costo de $5.000 para contratar a una persona experimentada en D es razonable en comparación con los otros ahorros propuestos.

Submit
168. Roger Fed está trabajando como director de proyecto en el proceso de planificar las comunicaciones de un proyecto de terapia biomolecular. El principal motivo por el cual Roger creará un plan de gestión de las comunicaciones será:

Explanation

Roger Fed creará un plan de gestión de las comunicaciones para comunicarse con todos los interesados en el proyecto de terapia biomolecular. Esto implica establecer una estrategia para asegurar que todas las partes involucradas en el proyecto estén informadas y actualizadas sobre el progreso, los cambios y cualquier otra comunicación relevante. Al establecer un plan de gestión de las comunicaciones, Roger podrá garantizar una comunicación efectiva y fluida con todos los interesados, lo que es esencial para el éxito del proyecto.

Submit
169. Gustavo está trabajando como director de un programa para la repavimentación de 50 carreteras en una región. El proyecto se encuentra en ejecución con un retraso de 30 días en relación a lo planificado. El principal motivo del retraso se debe a factores climáticos fuera del alcance del director del programa. Lamentablemente las tormentas de nieve en la montaña están durando más de lo normal y las tareas en las carreteras de alta montaña están paralizadas. Por tal motivo, Gustavo re-planifica el orden de las carreteras a re-pavimentar y comienza a trabajar con aquellas carreteras cuyo comienzo estaba planificado dentro de 60 días. Esto es un ejemplo de:

Explanation

In this scenario, Gustavo is facing a delay in the project due to unforeseen weather conditions that are beyond his control. As a result, he decides to re-plan the order of the roads to be repaved and starts working on those roads whose start was planned within 60 days. This demonstrates the use of discretionary dependencies, where Gustavo has the flexibility to rearrange the sequence of tasks based on his discretion to mitigate the impact of the delay caused by external factors.

Submit
170. Un buen director de proyecto, en lugar de preguntar por el porcentaje de avance de las actividades, sin poder hacer una verificación de avance real del proyecto, podría utilizar algún otro tipo de reglas para gestionar los avances del proyecto. Por ejemplo, podría asignar un 50% de avance cuando la actividad comienza y colocar otro 50% de avance cuando la actividad finaliza. ¿Cuál de los siguientes ítems NO está relacionado con técnicas para gestionar los avances del proyecto?

Explanation

The correct answer is "Principio 80/20". This is because the question asks for the item that is NOT related to techniques for managing project progress. The other options, "Asignar solamente 100% de avance una vez que la tarea finaliza, sino mantener la actividad con un avance de 0%", "Regla 20/80", and "Regla 50/50" are all examples of rules or techniques for managing project progress. However, "Principio 80/20" is not a recognized technique or rule for managing project progress.

Submit
171. Una empresa trabaja con un enfoque de gestión de la calidad total (TQM). Además, utiliza sistemas para la gestión de materias primas con un enfoque justo a tiempo (JIT). Para realizar el control de calidad de sus proyectos la empresa utiliza "las siete herramientas básicas". ¿Cuál de los ítems siguientes NO forma parte de alguna de estas siete herramientas básicas para el control de calidad?

Explanation

The correct answer is "Muestreo estadístico". The seven basic tools for quality control include the fishbone diagram, histogram, flowchart, check sheet, Pareto chart, control chart, and scatter diagram. Sampling is not included in these seven tools, as it is a separate technique used for gathering data and making inferences about a larger population. Sampling is commonly used in statistical analysis but is not considered one of the basic tools for quality control.

Submit
172. En relación a los grupos de procesos de la dirección de proyectos, señale la respuesta CORRECTA:

Explanation

The correct answer states that the groups of processes in project management are not phases of the project. This means that the groups of processes, which include initiating, planning, executing, monitoring and controlling, and closing, are not sequential stages that occur one after another in a project. Instead, these groups of processes are overlapping and iterative, meaning that they can occur throughout the project lifecycle and may be revisited and revised as needed. This understanding is important in project management as it helps to ensure that the processes are applied appropriately and effectively to achieve project success.

Submit
173. Durante la planificación de un proyecto, se están utilizando técnicas para evaluar los costos de la calidad. El director del proyecto está preocupado porque en la empresa donde se ubica el proyecto los costos de falla son muy elevados por la falta de aplicación de medidas proactivas. Los siguientes ejemplos son costos de conformidad de la calidad, a EXCEPCIÓN de ___________ que es un costo de falla o de calidad deficiente.

Explanation

During project planning, techniques are being used to evaluate the costs of quality. The project manager is concerned because in the company where the project is located, failure costs are very high due to the lack of proactive measures. The given examples, maintenance, training, and inspection, are all costs associated with ensuring quality and conforming to standards. However, corrective actions are costs incurred due to quality failures or deficiencies, making them an exception among the listed options.

Submit
174. Uno de los miembros del equipo está trabajando con 5 proyectos. Le informa al director de proyecto que no tiene claro a cuál de esos proyectos debe asignarle mayor importancia. ¿Quién es el encargado de priorizar los proyectos en la empresa?

Explanation

The correct answer is "La oficina de gestión de proyectos" because they are responsible for prioritizing projects in the company. They have the knowledge and expertise to assess the importance and impact of each project and allocate resources accordingly. The director of the project may provide input and guidance, but ultimately it is the responsibility of the project management office to prioritize the projects. The team of the project may also provide input, but the final decision lies with the project management office. The client may have input on project priorities, but they are not the primary decision-maker in this scenario.

Submit
175. El principal rol del director del proyecto es integrar todas las partes del proyecto en un todo cohesivo y comunicar. Si se estima que el director del proyecto trabajará 1.500 horas en un proyecto aeroespacial en una organización orientada por proyecto, ¿Cuántas horas dedicará aproximadamente el director del proyecto a la comunicación con los interesados?

Explanation

The director of the project is responsible for integrating all project parts into a cohesive whole and communicating. If the director is estimated to work 1,500 hours on an aerospace project in a project-oriented organization, it can be inferred that a significant portion of those hours will be dedicated to communication with stakeholders. Therefore, the director will approximately spend 1,350 hours on communication with stakeholders.

Submit
176. Usted es el director de proyecto para la perforación de un túnel. Se encuentra reunido con su equipo de trabajo en la reunión semanal de coordinación del proyecto. ¿Qué es lo MÁS importante que debería tener en cuenta en esa reunión?

Explanation

The most important thing to consider in the weekly coordination meeting of the tunnel drilling project is the identification of risks. This is crucial because it allows the project director and the team to proactively assess potential threats and develop strategies to mitigate them. By identifying risks, they can prioritize them and allocate resources accordingly, ensuring the project's success and minimizing any negative impacts. This step is essential for effective project management and ensuring the safety and efficiency of the tunnel drilling process.

Submit
177. Un Director de proyecto en una estructura matricial fuerte está con bastantes dificultades para recibir cooperación de los miembros de su equipo. ¿Por qué puede estar pasando esto? Porque los miembros del equipo______________

Explanation

Los miembros del equipo pueden estar teniendo dificultades para cooperar debido a que no participaron en la creación de la estructura de desglose del trabajo. Esto significa que no se sienten involucrados en el proceso de toma de decisiones y no tienen una comprensión clara de sus roles y responsabilidades dentro del proyecto. Como resultado, pueden no sentirse motivados para colaborar y pueden tener dificultades para trabajar en conjunto de manera efectiva.

Submit
178. El director del proyecto está realizando el monitoreo de los riesgos durante la etapa de ejecución del proyecto. ¿Cuál de las siguientes herramientas será la MENOS probable que utilice para llevar a cabo estas actividades?

Explanation

The director del proyecto is performing risk monitoring during the project execution phase. Sensitivity analysis is a tool used to assess the impact of varying input values on the outcomes of a project. It is less likely to be used for risk monitoring as it focuses on analyzing the effect of changes in specific variables, rather than identifying and assessing risks. Therefore, the director is unlikely to use sensitivity analysis as a tool for risk monitoring during the project execution phase.

Submit
179. Has sido asignado como director de un proyecto para la elaboración de una Sociedad de garantía Recíproca a los fines de financiar un clúster productivo en tu país. Estas trabajando en una organización matricial fuerte. Uno de los miembros de tu equipo de proyecto está ocasionando problemas desde el momento de su concepción. No sólo está agotando tu paciencia sino que tiene problemas con el resto de los miembros del equipo. Esta persona quiere sabotear el proyecto ya que no se siente cómodo ni con el proyecto ni con sus compañeros de equipo. ¿Qué deberías hacer?

Explanation

In this scenario, the team member is causing problems and wants to sabotage the project. It is important to address this issue to ensure the success of the project. By requesting the senior management to reassign the team member to another project where they feel more comfortable, it allows for a resolution that benefits both the team member and the project. This approach acknowledges the team member's discomfort and seeks a solution that promotes a positive working environment and maintains the project's progress.

Submit
180. Según los datos de la tabla a continuación, señale el costo presupuestado total a la finalización (BAC):

Explanation

not-available-via-ai

Submit
181. María le informa privadamente que Jorge, un empleado de atención al cliente, está tratando de boicotear el proyecto. María ha solicitado repetidamente a Jorge que no se comporte de esa manera, pero el problema persiste. ¿Cuál es el mejor curso de acción en su rol de director del proyecto?

Explanation

The best course of action in this situation would be to contact the functional manager in charge of Jorge to coordinate a meeting to discuss this issue. This allows for a formal and professional approach to addressing the problem, involving the appropriate authority to handle the situation. It also provides an opportunity for all parties involved to openly communicate and find a resolution to the issue.

Submit
182. Un proyecto complejo para detectar la demanda potencial de un nuevo producto se desarrolla en varios países simultáneamente, con interesados localizados físicamente entre los distintos países. Los paquetes de trabajo de la estructura de desglose del trabajo necesitan integrarse con aquellos definidos y realizados por el cliente. ¿Qué es lo MEJOR que puede utilizar el director de proyectos para controlar esta situación?

Explanation

The director of the project can use a "Sistema de autorización del trabajo" (Work Authorization System) to control the situation. This system will help in coordinating and integrating the work packages defined and performed by the client, as well as manage the approval and authorization process for the work. It ensures that all stakeholders are aligned and that the work is carried out according to the project requirements and objectives.

Submit
183. Usted está clasificando a los interesados teniendo en consideración el rasgo sobresaliente de cada grupo. ¿A cuál de estos rasgos de los interesados le daría MENOR prioridad?

Explanation

The question asks for the trait that would be given the least priority when classifying the interested parties. The correct answer is "Poder" which translates to "Power" in English. This means that power is the trait that would be considered the least important when categorizing the interested parties.

Submit
184. En un gran proyecto donde hay 120 trabajadores, 25 empresas contratistas directas y 12 empresas sub-contratistas, es muy importante que se planifique en detalle el sistema de autorización del trabajo, ¿Cuál será la principal ventaja de este sistema?

Explanation

The main advantage of planning the work authorization system in detail is to ensure that the work is carried out in the correct sequence. This is crucial in a large project with multiple contractors and subcontractors, as it helps to avoid any confusion or overlap in tasks. By establishing a clear sequence of work, it becomes easier to coordinate and manage the various activities, ensuring that they are executed in the most efficient and effective manner. This helps to minimize delays, improve productivity, and maintain a smooth workflow throughout the project.

Submit
185. La validación del alcance del proyecto finaliza cuando ________

Explanation

The validation of the project scope ends when each phase of the project is completed. This means that at the end of each phase, the project team reviews and confirms that the deliverables and objectives of that particular phase have been achieved. This helps to ensure that the project is progressing according to plan and that the scope is being properly managed and controlled throughout the entire project lifecycle.

Submit
186. El proyecto tiene una duración estimada de seis meses según su ruta crítica, sin considerar reservas para contingencia. El Cliente le pide que debe entregar el proyecto 30 días antes de lo previsto, por lo que ahora el proyecto tiene una holgura negativa. ¿Qué debería hacer?

Explanation

The correct answer is "Informar al Cliente sobre el impacto de ese cambio". This is the appropriate action to take when faced with a negative slack or a change in project timeline. By informing the client about the impact of the change, they can understand the potential consequences and make an informed decision. It is important to communicate any changes or issues to the client to maintain transparency and manage expectations.

Submit
187. Una vez que se aprueba el acta de constitución del proyecto, ¿Cuál debería ser el próximo paso?

Explanation

After the approval of the project charter, the next step should be to share the project charter with key stakeholders. This is important because it ensures that all relevant parties are aware of the project's objectives, scope, and constraints. Sharing the project charter with stakeholders allows them to provide feedback, ask questions, and align their expectations with the project's goals. It also helps in establishing clear communication channels and building a shared understanding among the project team and stakeholders. This step is crucial in setting the foundation for successful project execution.

Submit
188. En una organización se han definido cuatro categorías principales para los recursos: mano de obra, suministros, materiales y equipos. Además, se vinculan esas categorías con un plan de cuentas para supervisar los costos del proyecto. ¿Qué representan esas categorías?

Explanation

The categories of manpower, supplies, materials, and equipment represent the breakdown structure of resources (RBS). The RBS is a hierarchical representation that organizes and categorizes the resources needed for a project. It helps in identifying and tracking the costs associated with each category of resources. The RBS is linked to the project's chart of accounts, which allows for effective monitoring and control of project costs.

Submit
189. Eres el director de proyectos de la sala de entretenimientos infantil "Niño Feliz". El edificio donde se desarrollarán las reuniones infantiles está en construcción. Estás terminando los cálculos de fechas de finalización temprana, finalización tardía, comienzo temprano y comienzo tardío de las actividades del proyecto, sin tener en cuenta las restricciones de recursos. Acabas de obtener la estimación de la duración para cada actividad del proyecto y el cronograma. ¿Cuál podría ser el próximo paso?

Explanation

The next step could be to level the resources and compress the schedule. This involves analyzing the resource availability and making adjustments to ensure a smooth flow of work without any resource constraints. Additionally, the schedule may need to be compressed by adjusting the durations of activities or overlapping them to meet project deadlines. This step is important to optimize resource utilization and ensure timely completion of the project.

Submit
190. Eres el director de proyecto para el desarrollo de un nuevo software. Este proyecto debe salir al mercado dentro de 30 días, caso contrario, tu competencia habrá llegado antes con un producto similar. El proyecto avanza acorde a lo planificado hasta que un miembro del equipo descubre un error que debe ser reparado. Esta reparación implica un cambio en el proyecto y la política de la empresa establece que requiere de la aprobación del Comité de control de cambios. Iniciar este proceso y obtener una respuesta del Comité requiere un mínimo de 15 días, lo que pone en peligro el cronograma del proyecto. ¿Qué deberías hacer?

Explanation

Given the time constraint and the potential impact of the competition launching a similar product before the project, it is necessary to address the error immediately. As the project director, you have the authority to make urgent changes without waiting for approval from the Change Control Committee. By informing the team to fix the error promptly, you can ensure that the project stays on track and meets the deadline.

Submit
191. El director del proyecto se encuentra en el proceso de definición de las actividades del proyecto. Este es un proceso gradual, por lo que decide planificar a nivel de detalle las actividades de los próximos 6 meses y dejar a nivel de componentes de planificación el resto. ¿Cuál NO sería un ejemplo de componentes de planificación?

Explanation

A milestone is a significant event or achievement in a project that represents progress towards the project's goals. It is not a component of planning, but rather a way to track and measure the project's progress. Therefore, milestones would not be an example of planning components in this context.

Submit
192. Un proyecto para la elaboración y comercialización de productos lácteos involucrará a 320 interesados. Planificar las comunicaciones será importantísimo a los fines de hacer un trabajo proactivo en relación a los conflictos que enfrentará este proyecto. ¿En qué grupo de procesos de la dirección del proyecto tendrás que gestionar el involucramiento de los interesados?

Explanation

In the execution phase of the project, the project manager will have to manage the involvement of stakeholders. This involves actively engaging and communicating with the 320 stakeholders involved in the project for the successful implementation and commercialization of dairy products. By effectively planning and executing communication strategies, the project team can proactively address any conflicts that may arise during the execution phase.

Submit
193. En un proyecto se ha contratado a un grupo de vendedores bajo un contrato de precio fijo más incentivo. Cuando el proyecto lleva un 75% de avance, el Cliente solicita un cambio en el alcance, por lo que los contratos deberán ser modificados. ¿Quién tiene la autoridad para realizar los cambios en el contrato?

Explanation

The correct answer is "El gerente del contrato." In a project where a group of salespeople has been hired under a fixed price plus incentive contract, when the project is 75% complete and the client requests a change in scope, the contract manager has the authority to make changes to the contract. The contract manager is responsible for overseeing and managing the contractual agreements and is in the best position to negotiate and implement any necessary changes to the contract based on the client's request.

Submit
194. ¿Cómo podría darse cuenta que la descomposición del proyecto ha llegado a un nivel de partición adecuado?

Explanation

The correct answer states that the decomposition of the project has reached an appropriate level of partition when time and cost estimates can be made for each work package. This suggests that the project has been broken down into small enough components that it is possible to accurately estimate the time and cost required for each individual task. This indicates a sufficient level of detail and granularity in the project's breakdown structure.

Submit
195. En un proyecto de producción en serie de perfumes para mujeres, el responsable de la calidad del proyecto es el _________

Explanation

In a serial production project of perfumes for women, the person responsible for the quality of the project is the Director del proyecto (Project Director). The Project Director is in charge of overseeing the entire project, including quality control and ensuring that all aspects of the project meet the required standards. They are responsible for coordinating and managing the project team, making decisions, and ensuring that the project is completed successfully within the specified quality parameters. The Inspector de calidad (Quality Inspector) may be part of the project team, but the ultimate responsibility lies with the Project Director. The Gerente de asegurar la calidad (Quality Assurance Manager) and Gerente de operaciones (Operations Manager) may have roles related to quality, but they are not specifically responsible for the overall quality of the project.

Submit
196. Los indicadores de avance según la Gestión del valor ganado informan que estamos recibiendo $1.3 por cada $ invertido. Sin embargo, sólo estamos a un 60% de avance de donde deberíamos estar según la línea base. ¿Qué es lo MEJOR que podría hacer en este proyecto?

Explanation

The best course of action in this project would be to implement compression. This means finding ways to complete the project within the given time frame, even though it is currently behind schedule. This could involve reallocating resources, adjusting priorities, or streamlining processes to speed up the project's progress. By implementing compression, the project can still be completed on time despite the current delay.

Submit
197. Un proyecto de $200 millones cuyo plazo estimado de finalización será en dos años está en ejecución. ¿Quién tendrá la autoridad para aceptar o rechazar un cambio solicitado?

Explanation

El comité de control de cambios tendrá la autoridad para aceptar o rechazar un cambio solicitado en el proyecto de $200 millones. El comité de control de cambios es responsable de evaluar y tomar decisiones sobre los cambios propuestos en el proyecto, asegurándose de que sean viables y estén alineados con los objetivos y requisitos establecidos. Como tal, tienen la autoridad final para aceptar o rechazar cualquier cambio solicitado en el proyecto.

Submit
198. Con tu equipo de trabajo ya han finalizado la EDT y estiman un plazo de duración del proyecto más probable de 8 meses y un costo estimado de $150.000. A pesar que ya comenzaron a ejecutar el proyecto, el Patrocinador no está conforme con esa estimación y te solicita que recortes ese presupuesto en un 10%. ¿Qué es lo MEJOR que podrías hacer?

Explanation

The best course of action in this situation would be to evaluate alternatives for reducing the scope of the project and/or re-estimating the costs. By doing so, you can find ways to cut down on the budget without sacrificing the quality or completion of the project. This approach allows you to address the sponsor's request for a budget cut while still ensuring that the project can be executed successfully. It also allows for a more realistic assessment of the project's financial requirements, taking into account any changes in scope or unforeseen circumstances that may have arisen since the initial estimation.

Submit
199. Estas en la fase de ejecución de un proyecto tecnológico que está utilizando metodologías ágiles para finalizar el proyecto en tan sólo 30 días. Cuál será tu responsabilidad MENOS importante:

Explanation

In the execution phase of a technology project using agile methodologies to finish in just 30 days, the least important responsibility would be to solve conflicts with a win-win scheme. While it is important to address conflicts, the priority in this scenario is to meet ethical standards, provide accurate and reliable information, and implement the correct project management processes. Solving conflicts with a win-win approach is still important, but it may be considered a lower priority compared to the other responsibilities mentioned.

Submit
200. Estas negociando un contrato de precio fijo con uno de los vendedores. Los ítems siguientes son estrategias de negociación a EXCEPCIÓN de:

Explanation

La escucha efectiva no es una estrategia de negociación, sino una habilidad que se utiliza durante el proceso de negociación. Implica prestar atención activa a lo que la otra parte está diciendo y demostrar comprensión y empatía. A través de la escucha efectiva, se pueden identificar las necesidades y preocupaciones de la otra parte, lo que facilita la búsqueda de soluciones mutuamente beneficiosas. En contraste, atacar, establecer una fecha límite y mentir son estrategias de negociación más agresivas y manipuladoras.

Submit
View My Results

Quiz Review Timeline (Updated): Jul 22, 2024 +

Our quizzes are rigorously reviewed, monitored and continuously updated by our expert board to maintain accuracy, relevance, and timeliness.

  • Current Version
  • Jul 22, 2024
    Quiz Edited by
    ProProfs Editorial Team
  • Mar 09, 2019
    Quiz Created by
    Hapolaya
Cancel
  • All
    All (200)
  • Unanswered
    Unanswered ()
  • Answered
    Answered ()
Los miembros del equipo de trabajo acaban de finalizar con la...
Tu Cliente no está conforme con el avance del proyecto y se...
Estás trabajando en un proyecto para la demolición de un...
En su empresa deciden que van a invitar a los vendedores a una...
Un proyecto ha estimado gastar como más probable un valor de...
A lo largo del ciclo de vida de un proyecto de $23 millones y un plazo...
El proyecto con ciclo de vida predictivo ha llegado a su etapa de...
Hay un grupo de interesados que no está colaborando con un...
En su proyecto están utilizando un software de gestión...
Usted tiene la opción de alquilar andamios para un proyecto de...
Usted está ejecutando un proyecto que involucra a 23...
Un proyecto para la instalación de torres para cables de...
Estás convencido de que la confianza, las relaciones estrechas...
Usted es el director de un proyecto que tiene un índice de...
Eres el director de un proyecto para una reingeniería de...
El gerente de control de calidad está utilizando un diagrama de...
Usted está terminando con la fase de inicio de un proyecto de...
En un proyecto el emisor envía el mensaje al receptor. Sin...
Usted necesita acortar la duración de su proyecto que ya...
La curva S es una gráfica que se utiliza para:
Estás en el proceso de validar el alcance de un entregable con...
Juan y María siempre discuten por temas relacionados con su...
Durante la ejecución de un proyecto de ampliación de un...
Según la figura, calcule el valor monetario esperado (VME) y...
En un proyecto de diseño industrial el director del proyecto...
El equipo de proyectos está desarrollando el plan para la...
Usted es el director de un proyecto de ampliación de un...
El proyecto ha entrado en su etapa de ejecución y todo avanza a...
¿Cuál de los siguientes enunciados NO es una ventaja...
¿Cuál es la desviación estándar de una...
Durante la ejecución de un proyecto de construcción de...
Un proyecto tiene al mes 3 un valor planificado de $300, un costo...
Usted contrató a la Empresa "Comerciales" para realizar el...
En un proyecto con una estructura matricial fuerte, las principales...
Suponga que un proyecto tiene 2 actividades críticas con la...
Usted está evaluando un proyecto de elaboración de...
Estas trabajando como director de proyecto para la construcción...
Durante el grupo de procesos de inicio, se están evaluando una...
El patrocinador ha firmado el acta de constitución del proyecto...
Usted y su equipo ya finalizaron el plan de gestión de riesgos...
El director del proyecto está discutiendo con el gerente de...
Usted está realizando un monitoreo y control del proyecto en...
Eres director del proyecto para la puesta en marcha de una planta...
El patrocinador de un proyecto está buscando el perfil ideal de...
Usted se encuentra planificando las necesidades de recursos para un...
En un proyecto complejo se ha definido a la variable "calidad" como la...
Su proyecto utiliza metodologías ágiles para desarrollar...
La estructura de desglose del trabajo suele ser utilizada para las...
Un proyecto se encuentra con un nivel de avance del 67%. La semana...
Uno de los miembros del equipo de proyecto le ha solicitado más...
Los siguientes interesados forman parte de un proyecto en una...
Usted es el director de un proyecto internacional que proveerá...
Usted y su equipo han decidido una intensificación del...
Usted está realizando un análisis cuantitativo del...
El director del proyecto y su equipo de trabajo ya han finalizado el...
A una de las grandes firmas consultoras del mundo se le incendiaron...
¿Qué nos indica la desviación estándar de...
Una compañía financiera está ampliando su cartera...
Según el siguiente informe de desempeño del proyecto con...
En una organización matricial balanceada, el director del...
En un proyecto de desarrollo de un nuevo alimento para ancianos,...
Eres el director de un proyecto que fabricará químicos...
Un proyecto indica un índice de desempeño del costo de...
Un proyecto de cambio tecnológico tiene varios interesados. Su...
Usted y su equipo se encuentran en el grupo de procesos que...
Eres el director del proyecto para la provisión de alimentos de...
Para cerrar exitosamente un proyecto es fundamental documentar los...
Eres el director de proyecto en una empresa de telecomunicaciones. Los...
Has sido asignado como director de proyecto para el lanzamiento del...
En un proyecto que ha entrado en su tercer año de...
Un proyecto tiene una duración estimada de 9 meses. En el...
Estas trabajando en un proyecto para la construcción de una...
La gerencia quiere analizar cómo va evolucionando el proyecto...
Usted ha sido asignado como director de proyecto para el diseño...
En un proyecto de cierre de una central nuclear, durante la etapa de...
Un proyecto grande y complejo para la ampliación de un puerto...
Usted ha finalizado la ejecución de 4 proyectos y en el informe...
El cliente solicita al director del proyecto realizar un cambio...
Junto a su equipo están tratando de estimar los costos...
Tu empresa está involucrada en un nuevo proyecto de...
Tu último proyecto sobre la redacción de un libro sobre...
En un proyecto relacionado con la desnutrición infantil, las...
En su proyecto han finalizado una EDT bastante compleja con varios...
Has estado trabajando como director de proyecto en la...
¿Durante qué etapa del ciclo de vida de un proyecto...
Un proyecto de explotación de recursos naturales está...
Un proyecto que consiste en la elaboración de un plan para la...
En una organización matricial balanceada, la mayoría de...
En un proyecto para la elaboración de mosto concentrado para la...
El comprador y el vendedor han celebrado un acuerdo formal por...
Usted está trabajando como director de proyecto en una mina a...
Según la siguiente matriz de riesgo probabilidad-impacto con...
Al momento de planificar la tecnología apropiada para realizar...
Un director de proyectos investiga las causas por las cuales varias...
Un proyecto requiere de una inversión inicial de $500.000 y...
Durante la gestión del alcance de un proyecto para instalar...
Deming es conocido por sus 14 pasos para la gestión de la...
Una empresa multinacional orientada por proyectos, cuenta con una...
En un proyecto para la elaboración de bio-gas utilizando los...
Germán es el director del proyecto de instalación de una...
En un proyecto hemos re-planificado el cronograma de tal forma de...
Un proyecto de telefonía satelital tiene un 80% de avance y se...
En tu proyecto de desarrollo e implementación de una interface...
El proyecto Caratriste que le han asignado no se parece a...
En el proyecto para la puesta en marcha de un nuevo hotel, ya han...
El gerente general de tu empresa de desarrollo de combustibles...
Una de las herramientas al momento de solicitar respuesta de los...
Su proyecto está atravesando por varios conflictos entre los...
En una reunión de avance de un proyecto de forestación,...
Eres director de un programa para el desarrollo productivo de una...
Tu proyecto sobre la puesta en marcha de una planta de reciclaje de...
Eres el director de un proyecto que involucra un equipo...
¿Quién será el responsable de la calidad en un...
Según los datos de la tabla a continuación,...
La PRINCIPAL clave para el éxito de un proyecto se da cuando:
Una empresa trabaja bajo una estructura matricial débil. El...
Usted es el director de un proyecto para la puesta en marcha de una...
En un proyecto de desarrollo inmobiliario de $23 millones y una...
En la dirección de un proyecto para la construcción de...
Durante la ejecución de un proyecto, el Cliente solicita un...
En el informe de cierre del proyecto, el gerente de la PMO le solicita...
Eres el director de un proyecto de construcción de un centro...
¿Con qué herramienta se examina la efectividad de las...
Estas evaluando un proyecto de exportación de frutas. Existen...
Se está trabajando en un proyecto para planificar el layout de...
La alta gerencia está evaluando distintos proyectos de...
Marcela está controlando su proyecto con revisiones...
Eres el director de proyecto y estás trabajando con siete...
Usted está trabajando como director de un proyecto de...
Luego de 10 meses de trabajo en tu proyecto has llegado a la fase de...
Un proyecto está en su etapa de ejecución y un grupo de...
Usted está trabajando en conjunto con el analista de negocios...
Las siguientes herramientas se utilizan para armar el cronograma del...
En un proyecto para abrir una empresa de mensajería, se ha...
Fuiste el director del proyecto para la instalación de 25...
En un proyecto de varias fases, durante cada etapa de control existen...
Un terremoto dañó las bases de datos de una...
El proyecto está llegando a su fin y el equipo de trabajo...
Según la información de la siguiente tabla, conteste las...
¿Cuál es la ruta crítica?
Si la actividad C cambia de 4 semanas a 11 semanas ¿Cuál...
¿Cuál es la holgura libre en semanas de la actividad D?
¿Qué ocurre con el proyecto si la actividad D demora 10...
En su empresa contrataron a Rubén Peuchene para la...
En el siguiente diagrama, las letras indican actividad y los...
En un proyecto de 400 días de duración, el equipo de...
Usted está trabajando como director de proyecto con...
Luego de varias iteraciones finalmente el equipo de proyecto ha...
Si quieres estimar con un buen nivel de precisión los costos...
Usted debe realizar las estimaciones de costo del proyecto lo...
Eres un PMP® certificado y estás como director de un...
Usted quiere identificar y documentar en su proyecto las...
Uno de los miembros de tu equipo te informa que cometieron un error en...
Un proyecto tiene un costo estimado a la finalización (BAC) de...
Durante la iniciación del proyecto, tres colegas amigos del...
Acabas de empezar a administrar un contrato cuando la gerencia general...
Tu empresa ha ganado una licitación para la construcción...
Durante la fase de ejecución de un proyecto de mejoras de una...
Según los datos de la pregunta anterior, ¿Cuál...
Su organización está orientada a proyectos de desarrollo...
En un proyecto para la construcción de un astillero,...
Eres el director de un proyecto y junto con tu equipo de trabajo...
Según los datos de la pregunta 99, ¿Cuál...
Usted lleva 25 años trabajando como líder de proyectos...
Durante la etapa de ejecución del proyecto el director del...
En un programa para el bien social, ya se ha definido con...
Usted debe finalizar el proyecto 4 semanas antes de lo planificado....
Roger Fed está trabajando como director de proyecto en el...
Gustavo está trabajando como director de un programa para la...
Un buen director de proyecto, en lugar de preguntar por el porcentaje...
Una empresa trabaja con un enfoque de gestión de la calidad...
En relación a los grupos de procesos de la dirección de...
Durante la planificación de un proyecto, se están...
Uno de los miembros del equipo está trabajando con 5 proyectos....
El principal rol del director del proyecto es integrar todas las...
Usted es el director de proyecto para la perforación de un...
Un Director de proyecto en una estructura matricial fuerte está...
El director del proyecto está realizando el monitoreo de los...
Has sido asignado como director de un proyecto para la...
Según los datos de la tabla a continuación,...
María le informa privadamente que Jorge, un empleado de...
Un proyecto complejo para detectar la demanda potencial de un nuevo...
Usted está clasificando a los interesados teniendo en...
En un gran proyecto donde hay 120 trabajadores, 25 empresas...
La validación del alcance del proyecto finaliza cuando ________
El proyecto tiene una duración estimada de seis meses...
Una vez que se aprueba el acta de constitución del proyecto,...
En una organización se han definido cuatro categorías...
Eres el director de proyectos de la sala de entretenimientos infantil...
Eres el director de proyecto para el desarrollo de un nuevo software....
El director del proyecto se encuentra en el proceso de...
Un proyecto para la elaboración y comercialización de...
En un proyecto se ha contratado a un grupo de vendedores bajo un...
¿Cómo podría darse cuenta que la...
En un proyecto de producción en serie de perfumes para mujeres,...
Los indicadores de avance según la Gestión del valor...
Un proyecto de $200 millones cuyo plazo estimado de...
Con tu equipo de trabajo ya han finalizado la EDT y estiman un plazo...
Estas en la fase de ejecución de un proyecto tecnológico...
Estas negociando un contrato de precio fijo con uno de los vendedores....
